Submitted:
14 January 2024
Posted:
16 January 2024
You are already at the latest version
Abstract
Keywords:
1. Introduction
2. Methodology
3. Bibliometric Analysis
3.1. Country Analysis
3.2. Publication Sources Analysis
3.3. Author Analysis

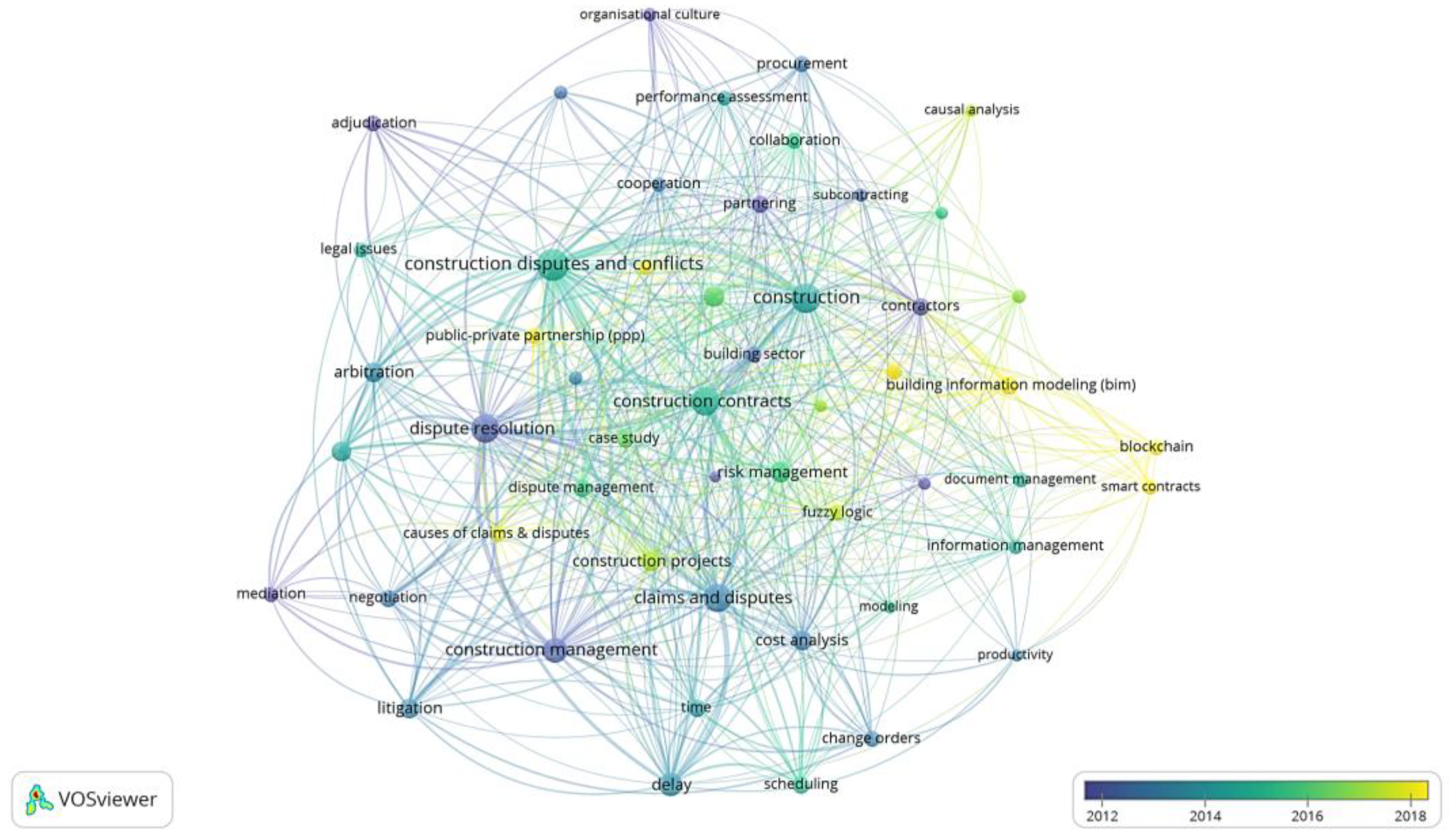

3.4. Main Research Areas (Co-Occurrence of Keywords Analysis)
4. Content Analysis of the Most Recent Publications
- Assessment of factors leading to claims/disputes
- The role of the human factor in construction conflicts
- Construction project performance
- Dispute resolution methods’ assessment
- Claims/Dispute management process models
- Methods for modelling and evaluating construction disputes.
- The publication type must be a journal article (36 conference papers excluded).
- Studies focusing on novel technologies, such as BIM, blockchain and smart contracts (22 documents included)
- Journal articles cited at least five times except for those focusing on novel technologies (139 documents excluded)
4.1. Assessment of Factors Leading to Claims/Disputes
4.2. The Role of the Human Factor in Construction Conflicts
4.3. Construction Project Performance
4.4. Dispute Resolution Methods’ Assessment
4.5. Claims/Dispute Management Process Models
4.6. Methods for Modelling and Evaluating Construction Disputes
![]() |
5. Current Research Trends
6. Conclusions
Author Contributions
Funding
Data Availability Statement
Conflicts of Interest
References
- Saygili, M.; Mert, IE; Tokdemir, O. B. A decentralized structure to reduce and resolve construction disputes in a hybrid blockchain network. Automation in Construction 2022, 134, 104056. [Google Scholar] [CrossRef]
- Chaphalkar, N.; Iyer, K.; Patil, S.K. Prediction of outcome of construction dispute claims using multilayer perceptron neural network model. International Journal of Project Management 2015, 33, 1827–1835. [Google Scholar] [CrossRef]
- Ibraheem, R.A.R.; Mahjoob, A.M.R. Facilitating claims settlement using building information modeling in the school building projects. Innovative Infrastructure Solutions 2022, 7, 1–17. [Google Scholar] [CrossRef]
- Cheung, S.O.; Yiu, T.W. Are construction disputes inevitable? IEEE Transactions on Engineering Management 2006, 53, 456–470. [Google Scholar] [CrossRef]
- Naji, KK; Mansour, M.M.; Gunduz, M. Methods for Modeling and Evaluating Construction Disputes: A Critical Review. IEEE Access 2020, 8, 45641–45652. [Google Scholar] [CrossRef]
- Mishmish, M.; El-Sayegh, S.M. Causes of claims in road construction projects in the UAE. International Journal of Construction Management 2018, 18, 26–33. [Google Scholar] [CrossRef]
- Ansari, R.; Khalilzadeh, M.; Taherkhani, R.; Antucheviciene, J.; Migilinskas, D.; Moradi, S. Performance Prediction of Construction Projects Based on the Causes of Claims: A System Dynamics Approach. Sustainability 2022, 14, 4138. [Google Scholar] [CrossRef]
- Arditi, D.; Patel, B.K. Expert system for claim management in construction projects. International Journal of Project Management 1989, 7, 141–146. [Google Scholar] [CrossRef]
- Cakmak, E.; Cakmak, PI. An analysis of causes of disputes in the construction industry using analytical network process. Procedia-Social Behavioral Sciences 2014, 109, 183–187. [Google Scholar] [CrossRef]
- Antoniou, F.; Tsioulpa, A. Assessing the delay, cost and quality risks of claims on construction contract performance. Preprints 2023. [Google Scholar] [CrossRef]
- ARCADIS. Global Construction Disputes Report -The road to early resolution; ARCADIS: 2021; p. 15.
- Hosseini, M.R.; Martek, I.; Zavadskas, E.K.; Aibinu, A.A.; Arashpour, M.; Chileshe, N. Critical evaluation of off-site construction research: A Scientometric analysis. Automation in Construction 2018, 87, 235–247. [Google Scholar] [CrossRef]
- Çevikbaş, M.; Işık, Z. An overarching review on delay analyses in construction projects. Buildings 2021, 11, 109. [Google Scholar] [CrossRef]
- Bar-Ilan, J. Which h-index?—A comparison of WoS, Scopus and Google Scholar. Scientometrics 2008, 74, 257–271. [Google Scholar] [CrossRef]
- Liang, H.; Zhang, S.; Su, Y. The structure and emerging trends of construction safety management research: a bibliometric review. International Journal of Occupational Safety and Ergonomics 2020, 26, 469–488. [Google Scholar] [CrossRef]
- Moher, D.; Liberati, A.; Tetzlaff, J.; Altman, D.G. Preferred reporting items for systematic reviews and meta-analyses: the PRISMA statement. BMJ 2009, 339, 332–336. [Google Scholar] [CrossRef] [PubMed]
- Van Eck, N.J.; Waltman, L. Manual for VOSviewer version 1.6.18. Univeristeit Leiden 2022, 1, 1–53. [Google Scholar]
- Osei-Kyei, R.; Chan, A.P.; Yu, Y.; Chen, C.; Dansoh, A. Root causes of conflict and conflict resolution mechanisms in public-private partnerships: Comparative study between Ghana and China. Cities 2019, 87, 185–195. [Google Scholar] [CrossRef]
- Cavadas, A. Visualizing the Collaboration Network of a European Marine Research Infrastructure: A Bibliometric and Social Network Analysis. U Porto Journal of Engineering 2020, 6, 98–118. [Google Scholar] [CrossRef]
- Mengist, W.; Soromessa, T.; Legese, G. Method for conducting systematic literature review and meta-analysis for environmental science research. MethodsX 2020, 7, 100777. [Google Scholar] [CrossRef]
- Perera, B.A.K.S.; Ekanayake, B.J.; Jayalath, C.; Jayathilaka, G.R.H. A study on variation-specific disputes that arise in road projects in Sri Lanka: a qualitative approach. International Journal of Construction Management 2021, 21, 571–581. [Google Scholar] [CrossRef]
- Sinha, A.K.; Jha, K.N. Dispute Resolution and Litigation in PPP Road Projects: Evidence from Select Cases. Journal of Legal Affairs and Dispute Resolution in Engineering and Construction 2020, 12, 05019007. [Google Scholar] [CrossRef]
- El-Sayegh, S.; Ahmad, I.; Aljanabi, M.; Herzallah, R.; Metry, S.; El-Ashwal, O. Construction disputes in the UAE: Causes and resolution methods. Buildings 2020, 10, 171. [Google Scholar] [CrossRef]
- Zaneldin, E.K. Investigating the types, causes and severity of claims in construction projects in the UAE. International Journal of Construction Management 2020, 20, 385–401. [Google Scholar] [CrossRef]
- Abdul Nabi, M.; El-Adaway, I.H. Understanding Disputes in Modular Construction Projects: Key Common Causes and Their Associations. Journal of Construction Engineering and Management 2022, 148, 04021184. [Google Scholar] [CrossRef]
- Ilter, O.; Celik, T. Investigation of organizational and regional perceptions on the changes in construction projects. Teknik Dergi 2021, 32, 11257–11286. [Google Scholar] [CrossRef]
- Tanriverdi, C.; Atasoy, G.; Dikmen, I.; Birgonul, M.T. Causal mapping to explore emergence of construction disputes. Journal of Civil Engineering and Management 2021, 27, 288–302. [Google Scholar] [CrossRef]
- Abdul Nabi, M.; El-adaway, I.H. Understanding the Key Risks Affecting Cost and Schedule Performance of Modular Construction Projects. Journal of Management in Engineering 2021, 37, 04021023. [Google Scholar] [CrossRef]
- Koc, K.; Pelin Gurgun, A. Assessment of readability risks in contracts causing conflicts in construction projects. Journal of Construction Engineering and Management 2021, 147, 04021041. [Google Scholar] [CrossRef]
- Chinyio, E.; Taiwo, A. Psychology in construction (PSYCON). In Proceedings of the 10th International Technology, Education and Development Conference, Valencia, Spain; 2016; p. 529. [Google Scholar]
- Eriksson, T.; Kadefors, A. Organisational design and development in a large rail tunnel project—Influence of heuristics and mantras. International Journal of Project Management 2017, 35, 492–503. [Google Scholar] [CrossRef]
- Lobel, I.B. Realities of interest based (win-win) bargaining. Labor Law Journal 1994, 45, 771. [Google Scholar]
- Abdul-Malak, M.-A.U.; Bou Hamdan, S.; Demachkieh, F.S. Enhanced roles and traits of the Engineer in assessing claims. Journal of Legal Affairs and Dispute Resolution in Engineering and Construction 2020, 12, 04520019. [Google Scholar] [CrossRef]
- Pishdad-Bozorgi, P.; Yoon, J.H. Transformational approach to subcontractor selection using blockchain-enabled smart contract as trust-enhancing technology. Automation in Construction 2022, 142, 104538. [Google Scholar] [CrossRef]
- Cheung, S.O.; Li, K.; Chow, O.Y. Reactive devaluation as a psychological impediment to construction dispute negotiation. Journal of Management in Engineering 2020, 36, 04020025. [Google Scholar] [CrossRef]
- Maqsoom, A.; Wazir, S.J.; Choudhry, R.M.; Thaheem, M.J.; Zahoor, H. Influence of Perceived Fairness on Contractors’ Potential to Dispute: Moderating Effect of Engineering Ethics. Journal of Construction Engineering and Management 2020, 146, 04019090. [Google Scholar] [CrossRef]
- Gunduz, M.; Elsherbeny, H.A. Critical assessment of construction contract administration using fuzzy structural equation modeling. Engineering, Construction and Architectural Management 2020, 27, 1233–1255. [Google Scholar] [CrossRef]
- Pradeep, A.S.E.; Yiu, T.W.; Zou, Y.; Amor, R. Blockchain-aided information exchange records for design liability control and improved security. Automation in Construction 2021, 126, 103667. [Google Scholar] [CrossRef]
- Sheng, D.; Ding, L.; Zhong, B.; Love, P.E.; Luo, H.; Chen, J. Construction quality information management with blockchains. Automation in Construction 2020, 120, 103373. [Google Scholar] [CrossRef]
- Gurgun, A.P.; Koc, K. Administrative risks challenging the adoption of smart contracts in construction projects. Engineering, Construction and Architectural Management 2022, 29, 989–1015. [Google Scholar] [CrossRef]
- Abd Jamil, A.H.; Fathi, MS. Enhancing BIM-Based Information Interoperability: Dispute Resolution from Legal and Contractual Perspectives. Journal of Construction Engineering and Management 2020, 146, 05020007. [Google Scholar] [CrossRef]
- Sonmez, R.; Ahmadisheykhsarmast, S.; Güngör, A.A. BIM integrated smart contract for construction project progress payment administration. Automation in Construction 2022, 139, 104294. [Google Scholar] [CrossRef]
- Bapat, H.; Sarkar, D.; Gujar, R. Application of multi-criteria decision making for evaluation of key performance indicators of integrated project delivery and BIM model for an infrastructure transportation project in Western India. International Journal of Construction Management 2023, 23, 2077–2086. [Google Scholar] [CrossRef]
- Jagannathan, M.; Delhi, VSK. Identifying focus areas to decode the decision to litigate contractual disputes in construction. Engineering, Construction and Architectural Management 2022, 29, 2976–2998. [Google Scholar] [CrossRef]
- Kisi, K.P.; Lee, N.; Kayastha, R.; Kovel, J. Alternative dispute resolution practices in international road construction contracts. Journal of Legal Affairs and Dispute Resolution in Engineering and Construction 2020, 12, 04520001. [Google Scholar] [CrossRef]
- Kumar, R.; Iyer, K.C.; Singh, S.P. Understanding relationship between risks and claims for assessing risks with project data. Engineering, Construction and Architectural Management 2020, 28. [Google Scholar] [CrossRef]
- Shahhosseini, V.; Hajarolasvadi, H. A conceptual framework for developing a BIM-enabled claim management system. International Journal of Construction Management 2021, 21, 208–222. [Google Scholar] [CrossRef]
- Kim, E.W.; Park, M.S.; Kim, K.; Kim, K.J. Blockchain-Based Automatic Tracking and Extracting Construction Document for Claim and Dispute Support. KSCE Journal of Civil Engineering 2022, 26, 3707–3724. [Google Scholar] [CrossRef]
- Ayhan, M.; Dikmen, I.; Talat Birgonul, M. Predicting the Occurrence of Construction Disputes Using Machine Learning Techniques. Journal of Construction Engineering and Management 2021, 147, 04021022. [Google Scholar] [CrossRef]
- Rai, H.; Jagannathan, M.; Delhi, VSK. Claim tenability assessment in Indian real estate projects using ANN and decision tree models. Built Environment Project and Asset Management 2020, 11, 468–487. [Google Scholar] [CrossRef]
- Ayhan, M.; Dikmen, İ.; Birgönül, M.T. Comparing Performances of Machine Learning Techniques to Forecast Dispute Resolutions. Teknik Dergi 2021, 33, 12577–12600. [Google Scholar] [CrossRef]
- Bektas, S.; Talat Birgonul, M.; Dikmen, I. Integrated Probabilistic Delay Analysis Method to Estimate Expected Outcome of Construction Delay Disputes. Journal of Legal Affairs and Dispute Resolution in Engineering and Construction 2021, 13, 04520037. [Google Scholar] [CrossRef]
- Kumar Viswanathan, S.; Panwar, A.; Kar, S.; Lavingiya, R.; Jha, K.N. Causal Modeling of Disputes in Construction Projects. Journal of Legal Affairs and Dispute Resolution in Engineering and Construction 2020, 12, 04520035. [Google Scholar] [CrossRef]
- Hamledari, H.; Fischer, M. Role of Blockchain-Enabled Smart Contracts in Automating Construction Progress Payments. Journal of Legal Affairs and Dispute Resolution in Engineering and Construction 2021, 13, 04520038. [Google Scholar] [CrossRef]
- Sinesilassie, E.G.; Tripathi, K.K.; Tabish, SZS; Jha, K.N. Modeling success factors for public construction projects with the SEM approach: Engineer’s perspective. Engineering, Construction and Architectural Management 2019. [CrossRef]
- Msawil, M.; Greenwood, D.; Kassem, M. A Systematic evaluation of blockchain-enabled contract administration in construction projects. Automation in Construction 2022, 143, 104553. [Google Scholar] [CrossRef]
- National Institute of Building Sciences. National Building Information Modeling Standard; National Institute of Building Sciences (NIBS): Washington DC, 2007; p. 183. [Google Scholar]
| 1 | Construction Contract Administration (CCA) is the process of ensuring each party’s proper performance in meeting their contractual obligations. |

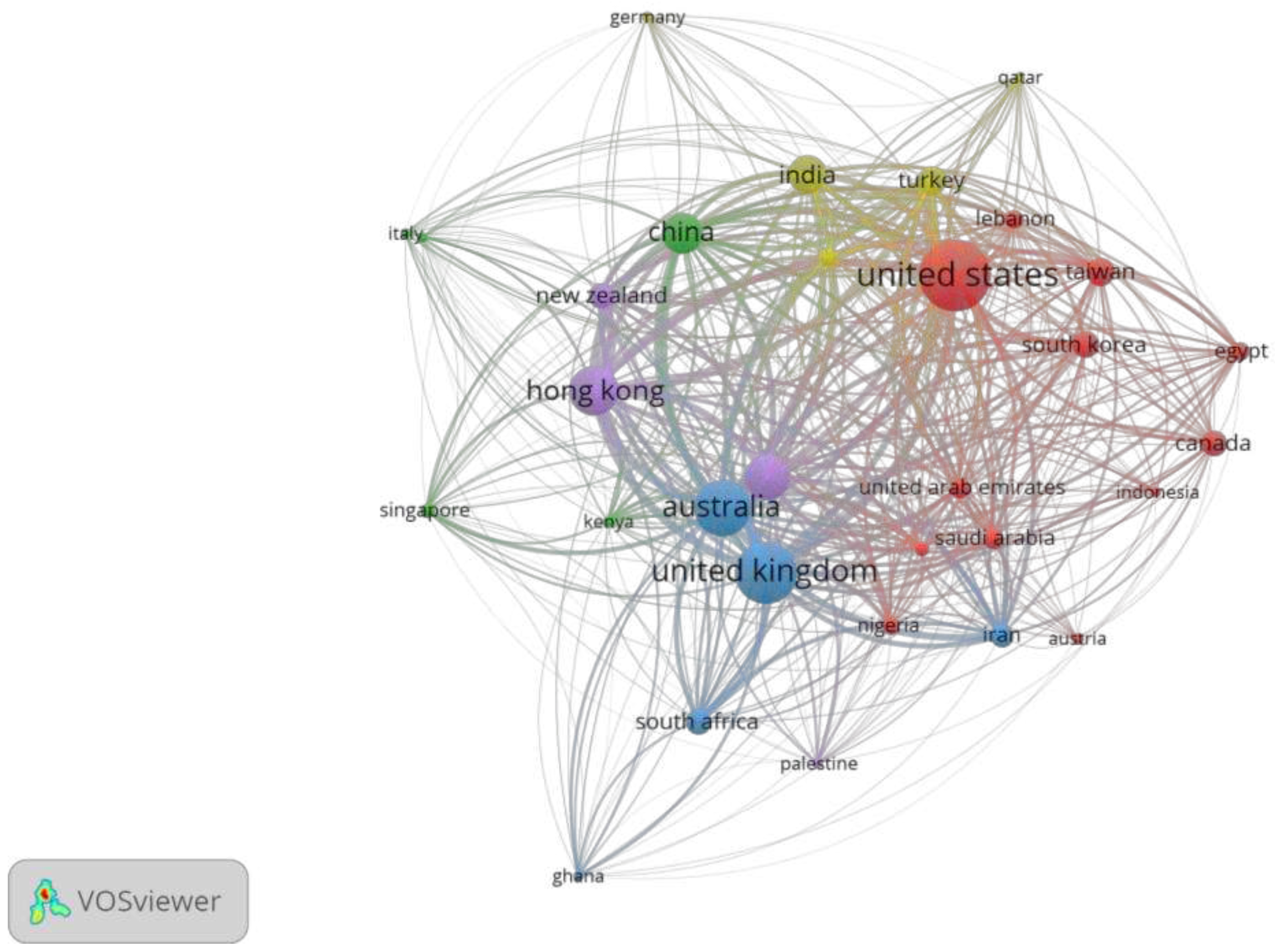

| ID | Country | Documents | Citations | Avg. Citations | Total Link Strength |
|---|---|---|---|---|---|
| 1 | Australia | 90 | 1294 | 14 | 12896 |
| 2 | Hong Kong | 74 | 2322 | 31 | 11374 |
| 3 | United States of America | 137 | 2102 | 15 | 10663 |
| 4 | United Kingdom | 107 | 1374 | 13 | 10634 |
| 5 | China | 54 | 1032 | 19 | 8797 |
| ID | Journals | Documents | Citations | Total Link Strength | Scopus Quartile |
|---|---|---|---|---|---|
| 1 | Journal of Construction Engineering and Management | 82 | 2538 | 331 | Q1 |
| 2 | Construction Management and Economics | 42 | 1222 | 207 | Q1 |
| 3 | Journal of Legal Affairs and Dispute Resolution in Engineering and Construction | 84 | 490 | 195 | Q1 |
| 4 | Engineering, Construction and Architectural Management | 31 | 428 | 161 | Q1 |
| 5 | Automation in Construction | 19 | 678 | 79 | Q1 |

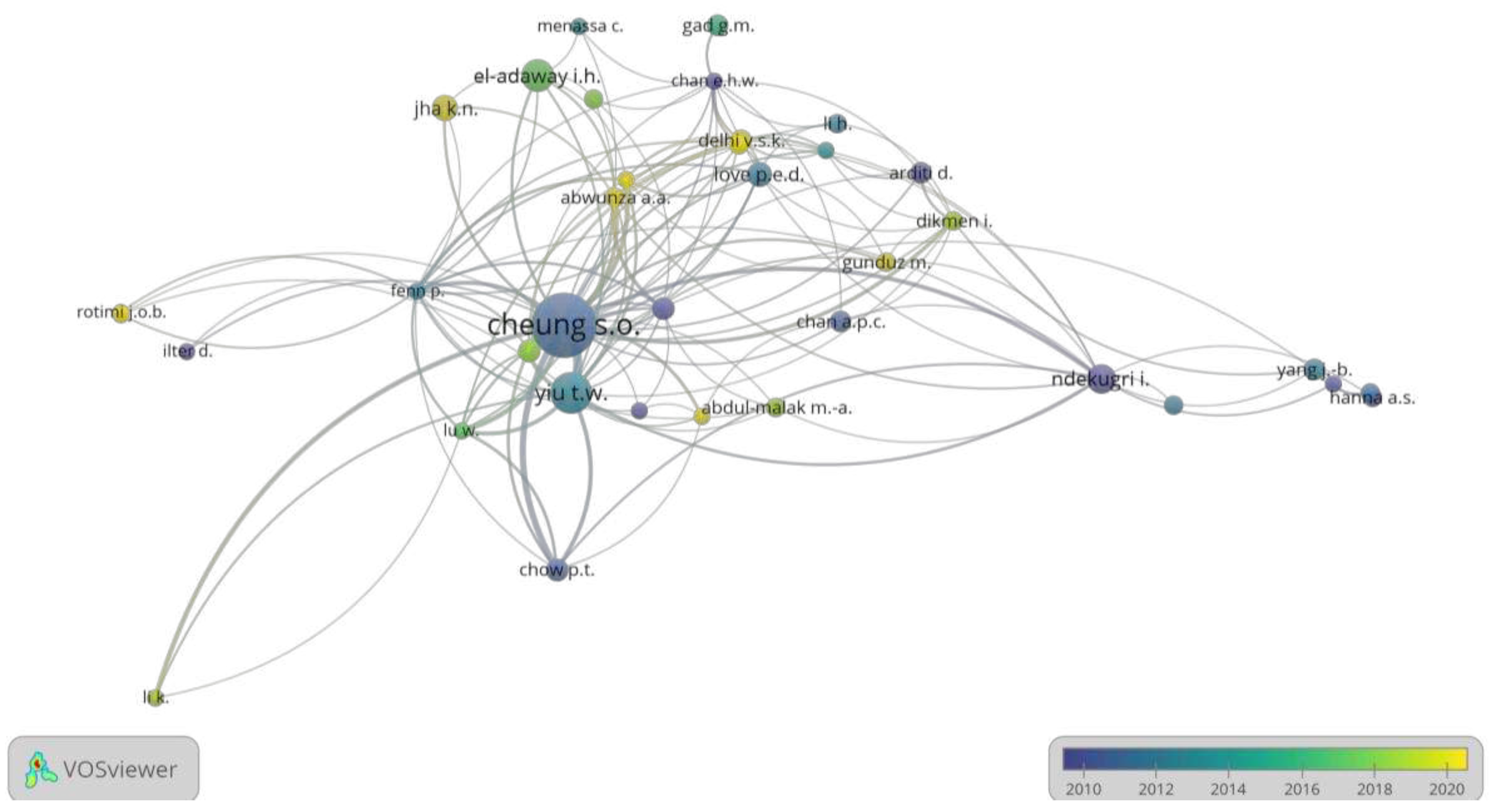

| ID | Author | Documents | Citations | Avg. Citations | Total Link Strength |
|---|---|---|---|---|---|
| 1 | Cheung S.O. | 45 | 1131 | 25 | 238 |
| 2 | Yiu T.W. | 21 | 363 | 17 | 125 |
| 3 | Chow P.T. | 8 | 102 | 13 | 56 |
| 4 | Fenn P. | 5 | 168 | 34 | 52 |
| 5 | Zhang L. | 8 | 86 | 11 | 50 |
| Ref. | Project Type/Sector | Country | Causes of Claims/Disputes | Other Findings |
|---|---|---|---|---|

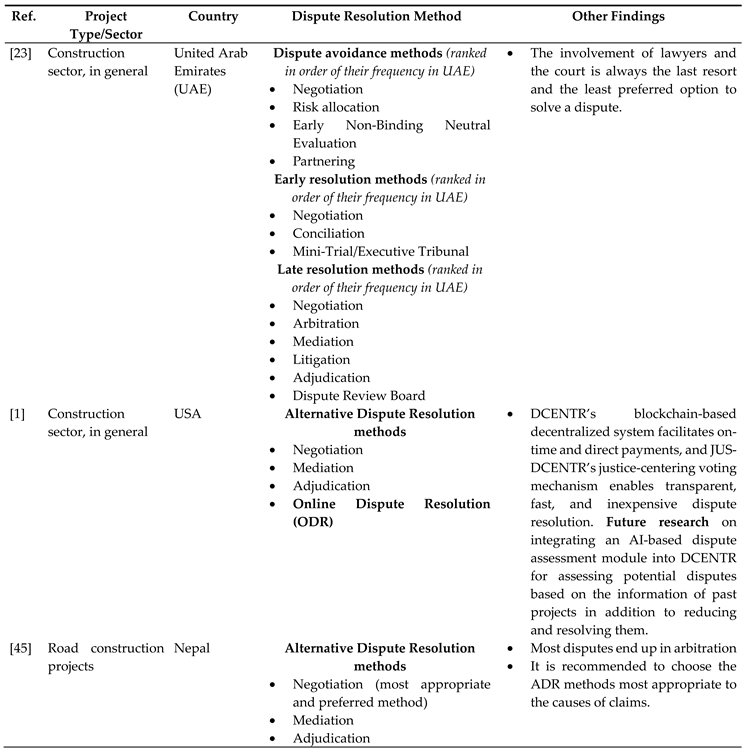

| [23] | Construction sector, in general | United Arab Emirates (UAE) |
|
|
| [24] | residential/ commercial buildings – highest % among all other types water & sewer lines roads & highways power plants hospitals airports |
United Arab Emirates (UAE) |
|
|
| [26] | Building construction projects (lump sum & design-bid-build) | North Cyprus Turkey USA |
Change factors – Categories
|
|
| [21] | Road projects | Sri Lanka |
Root causes of variations
|
Suggestions to reduce/manage potential variation-related disputes
|
| [25] | Modular construction projects | USA |
|
|
| [29] | n/a | n/a |
Contract Readability risks
|
|
| [22] | Road Projects (Transport PPP Sector) |
India |
|
Recommendations to avoid disputes
|
![]() |
| Ref. | Factors Affecting Project Performance | Methodology | Important Findings |
|---|---|---|---|
| [37] |
|
|
|
| [38] |
|
|
|
| [39] |
|
|
|
| [40] |
|
Examination of the administrative risks of smart contracts that limit the widespread use of their implementation via:
|
The top five risks challenging the adoption of smart contracts in construction projects are:
|
| [41] |
|
|
|
| [42] |
|
|
|
| [43] |
|
|
|
![]() |
![]() |
| Ref. | Novel Technologies | Project Phase | Research Theme (Related Content Analysis Section) |

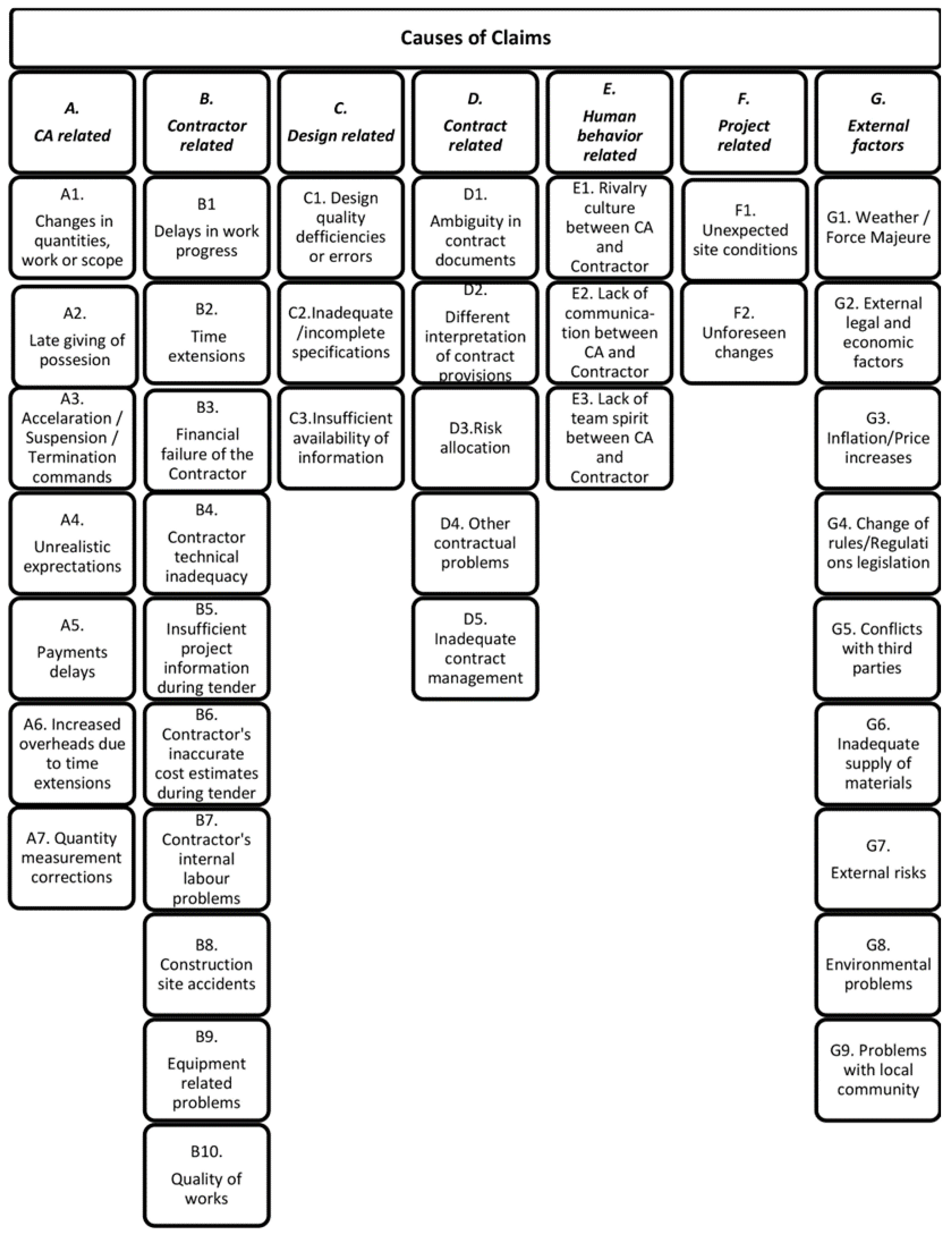

Causes of Claims (CCBS Code from Figure 1) |
|---|---|---|---|---|
| [5] | Fuzzy Logic & SEM | Pre-construction | Methods for modelling and evaluating construction disputes (4.6) | - |
| [42] | Smart contract & BIM | Construction | Construction project performance (4.3) | Payment delays (A5) |
| [48] | Blockchain | Construction | Claims/Dispute management process models (4.5) | Inadequate Document management (D5) |
| [38] | Design/ Construction/ Post-construction | Construction project performance (4.3) | Change of scope (A1), Insufficient availability of information (C3) | |

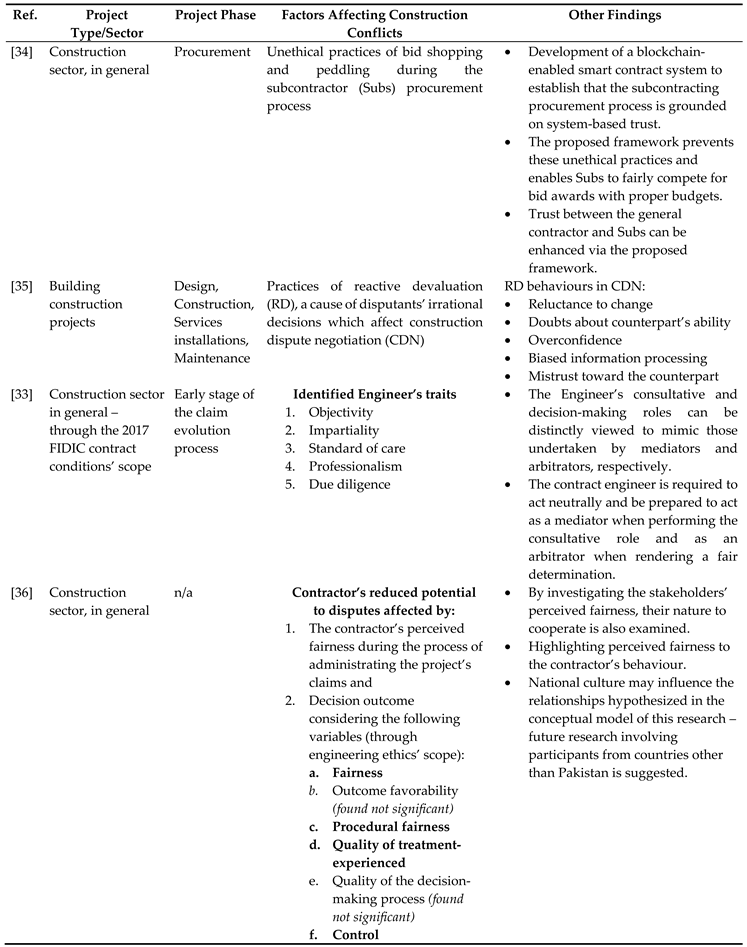

| [34] | Smart contract & blockchain | Procurement | The role of the human factor in construction conflicts (4.2) | Quality of works (B10) |
| [1] | Construction | Dispute resolution methods’ assessment (4.4) | Payment delays (A5), Ambiguity in contract documents (D1) | |
| [39] | Construction | Construction project performance (4.3) | Quality of works (B10) | |

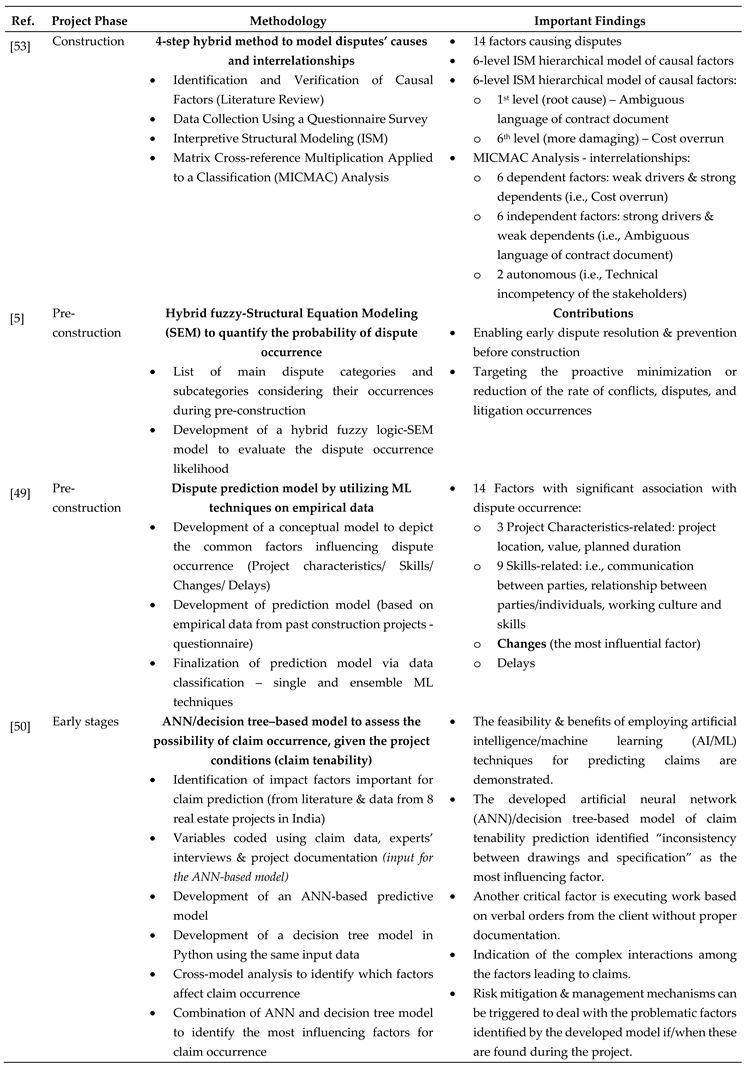

| [50] | AI/ML/NN | Construction (early stages) | Methods for modelling and evaluating construction disputes (4.6) | Inadequate/ incomplete specifications (C2), Lack of communication between CA and Contractor (E2) |
| [49] | Pre-construction | Methods for modelling and evaluating construction disputes (4.6) | Delays in work progress (B1), Change of scope (A1), Project characteristics (F1, F2) | |
| [47] | BIM | Construction | Claims/Dispute management process models (4.5) | Insufficient availability of information (C3) |
| [3] | Design | Claims/Dispute management process models (4.5) | Design errors (C1), lack of communication between CA and Contractor (E2), Changes in quantities, work or scope (A1), Inadequate/ incomplete specifications (C2) | |
| [40] | Smart Contract | Life-cycle | Construction project performance (4.3) | Contract related (D1. D2, D3, D4, D5) |
