2. Materials and Methods
2.1. A Reduced Background of Statistical Concepts
This section is essential to
understand the “problems related to I-CC” as we found in the literature. We
suggest it for the formulae given and for the difference between the concepts
of PI (Probability Interval, NOT “Prediction Interval”) and CI (Confidence
Interval): this is overlooked in “The Garden …
[24]
” (a sample is in the
Appendix C
).
See a first case in the appendix
A. Therefore, we humbly ask the reader to carefully meditate on the content.
Engineering Analysis is related to
the investigation of phenomena underlying products and processes; the analyst
can communicate with the phenomena only through the observed data,
collected with sound experiments (designed for the purpose): any phenomenon, in
an experiment, can be considered as a measurement-generating process
[MGP, a black box that we do not know] that provides us with information about
its behaviour through a measurement process [MP, known and managed by
the experimenter], giving us the observed data (the “message”).
It is a law of nature that the
data are variable, even in conditions considered fixed, due to many unknown
causes.
MGP and MP form the Communication
Channel from the phenomenon to the experimenter.
The information, necessarily
incomplete, contained in the data, has to be extracted using sound statistical
methods (the best possible, if we can). To do that, we consider a statistical
model F(x|
θ
) associated with a random variable (RV) X giving rise to the
measurements, the “determinations” {x1, x2, …, xn}=D
of the RV, constituting the “observed sample” D; n is the sample size.
Notice the function F(x|
θ
) [a function of real numbers, whose form we assume we know] with
the symbol
θ
accounting for an unknown quantity (or some unknown quantities)
that we want to estimate (assess) by suitably analysing the sample D.
We indicate by
the pdf (probability density
function) and by
the Cumulative Function, where
is the set of the parameters of
the functions.
When
we have the Normal model,
written as
(x|
), with (parameters) mean E[X]=
μ
and variance
Var[X]=
σ
2
When
we have Exponential model,
with (the single parameter) mean E[X]=
(variance Var[X]=
2
), written in two equivalent ways
.
When we have the observed
sample D={x1, x2, …, xn}, our general
problem is to estimate the value of the parameters of the model (representing
the parent population) from the information given by the sample. We
define some criteria which we require a "good" estimate to satisfy
and see whether there exist any "best" estimates. We assume that the
parent population is distributed in a form, the model, which is completely
determinated but for the value
θ
0
of some parameter, e.g.
unidimensional,
θ
, or bidimensional
θ
={
μ
,
σ
2
}; we consider only one or two
parameters, for easiness.
We seek some function of
θ
, say
τ
(
θ
), named inference
function, and we see if we can find a RV T which can have the following
properties: unbiasedness, sufficiency, efficiency. Statistical Theory allows us
the analysis of these properties of the estimators (RVs).
We use the symbols
and
for the unbiased estimators T1
and T2 of the mean and the variance.
Luckily, we have that T1,
in the Exponential model
, is efficient
[6–21,25–33]
, and it extracts the
total available information from any random sample, while the couple T1
and T2, in the Normal model, are jointly sufficient
statistics for the inference function
τ
(
θ
)=(
μ
,
σ
2
), so
extracting the maximum possible of the total available information from any
random sample. The estimators (which are RVs) have their own “distribution”
depending on the parent model F(x|
θ
) and on the sample D: we use the symbol
for that “distribution”. It is
used to assess their properties. For a given (collected) sample D the estimator
provides a value t (real number) named the estimate of
τ
(
θ
),
unidimensional.
A way of finding the estimate is
to compute the Likelihood Function
[LF] and to maximise it: the
solution of the equation
=0 is termed Maximum Likelihood
Estimate [MLE].
The LF is important because it
allows us finding the MVB (Minimum Variance Bound, Cramer-Rao theorem)
[1,2,6–16,26–36]
of an unbiased RV
T [related to the inference function
τ
(
θ
)], such that
The inverse of the MVB(T) provides
a measure of the total available amount of information in D, relevant to
the inference function
τ
(
θ
) and to the statistical model F(x|
θ
).
Naming IT(T) the
information extracted by the RV T we have that
[6–21,26–36]
IT(T)=1/MVB(T)
⇔
T is an
Efficient Estimator.
If T is an Efficient Estimator
there is no better estimator able to extract more information from D.
The estimates considered before
were “point estimates” with their properties, looking for the “best”
single value of the inference function
τ
(
θ
).
We must now introduce the concept

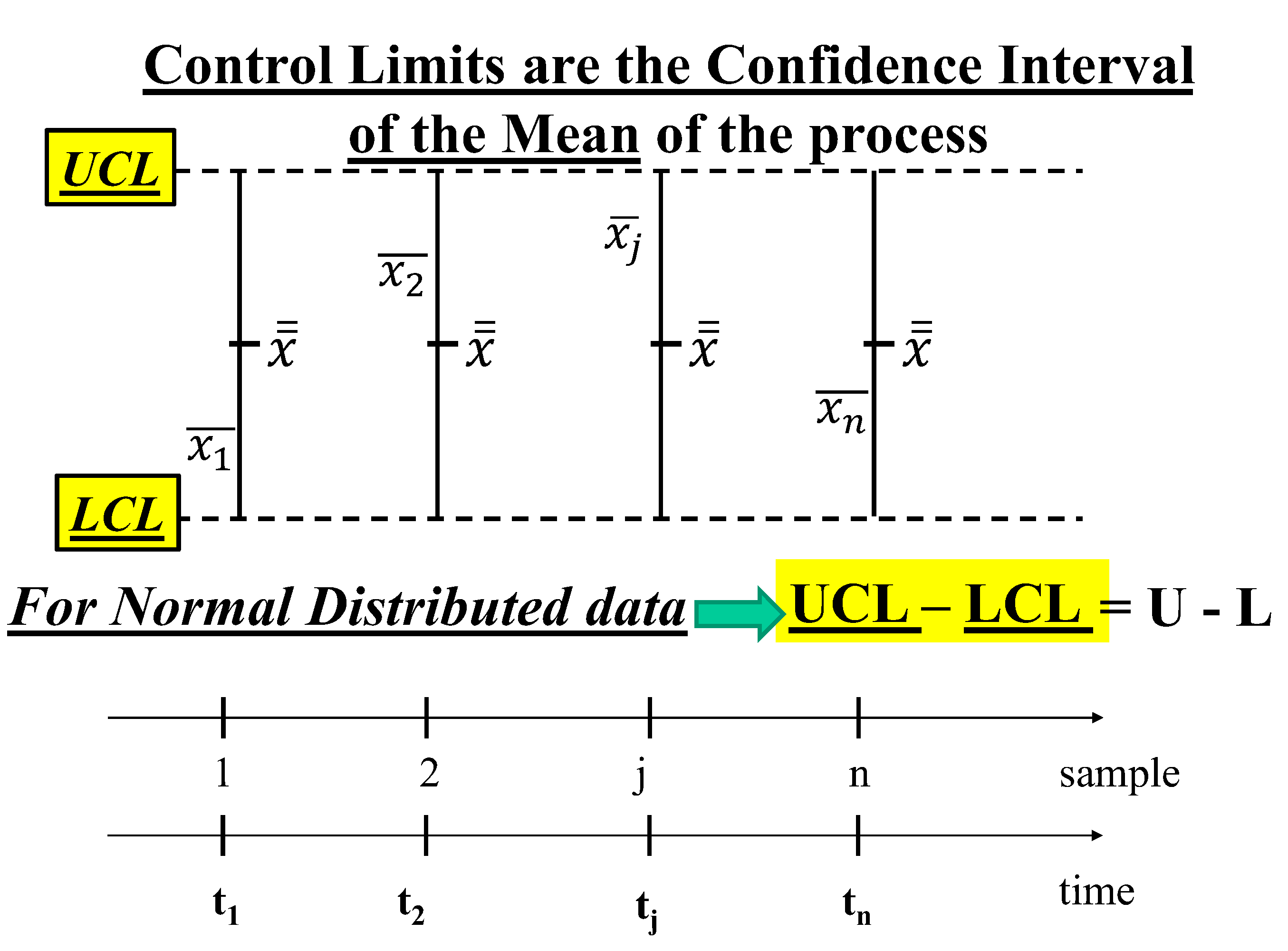

of Confidence Interval (CI) and Confidence Level (CL)
[6–21,26–36]
.
The “interval estimates”
comprise all the values between
τ
L
(Lower
confidence limit) and
τ
U
(Upper confidence limit); the CI is
defined by the numerical interval CI=
{τ
L
-----
τ
U
}
, where
τ
L
and
τ
U
are two quantities computed from the observed sample D: when
we make the statement that
τ
(
θ
)
∈
CI, we accept, before any computation, that, doing that, we can be
right, in a long run of applications, (1-
α
)%=CL of the applications,
BUT we cannot know IF we are right in the single application (CL=Confidence
Level).
We know, before any computation,
that we can be wrong
α
% of the times but we do not know when it happens.
The reader must be very careful
to distinguish between the Probability Interval
PI=
{
L
-----U
}
, where the
endpoints L and U depends on the distribution
of the estimator T (that we
decide to use, which does not depend on the “observed sample” D) and, on
the probability
π
=1-
α

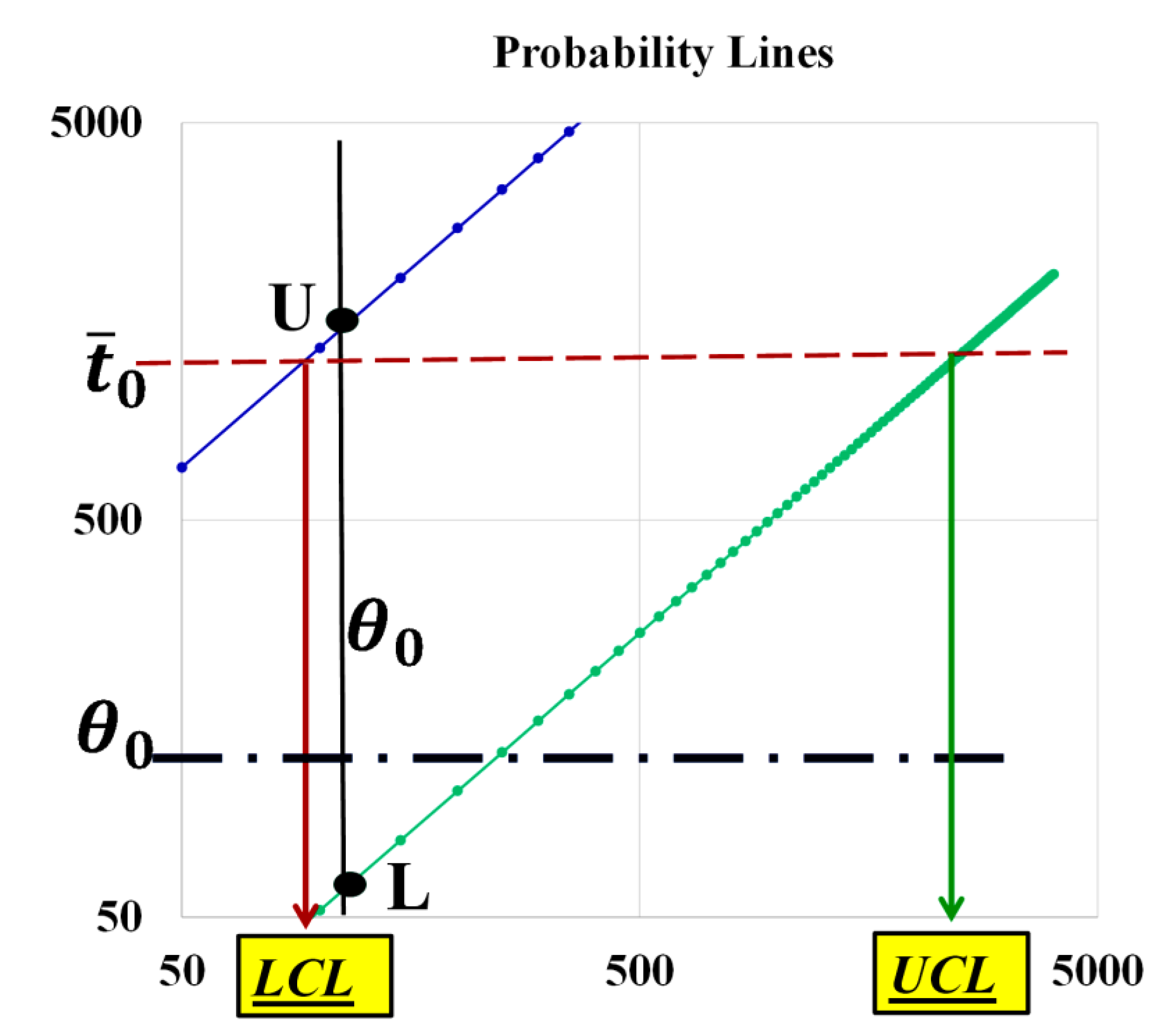

(that we fix before any computation), as follows by the

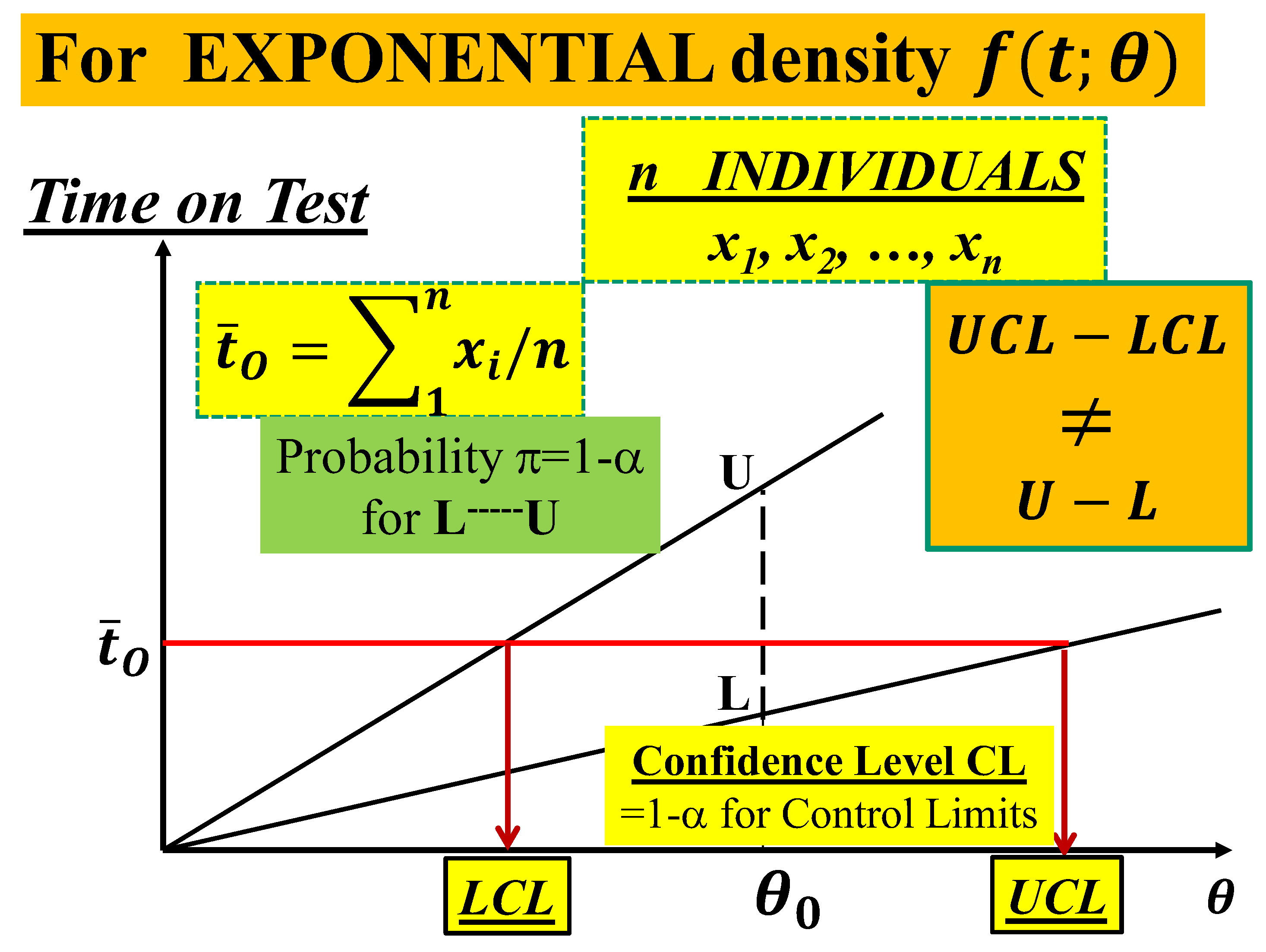

probabilistic statement (4) [se the
Figure
1
for the exponential density, when n=1]
and Confidence Interval CI=
{τ
L
-----
τ
U
}
which depends on the “observed sample” D.
Notice that the Probability
Interval PI=
{
L-----U
}
does not depend on the data D: L and U are the
Probability Limits. Notice that, on the contrary, the Confidence Interval CI=
{τ
L
-----
τ
U
}
does depend on the data D.

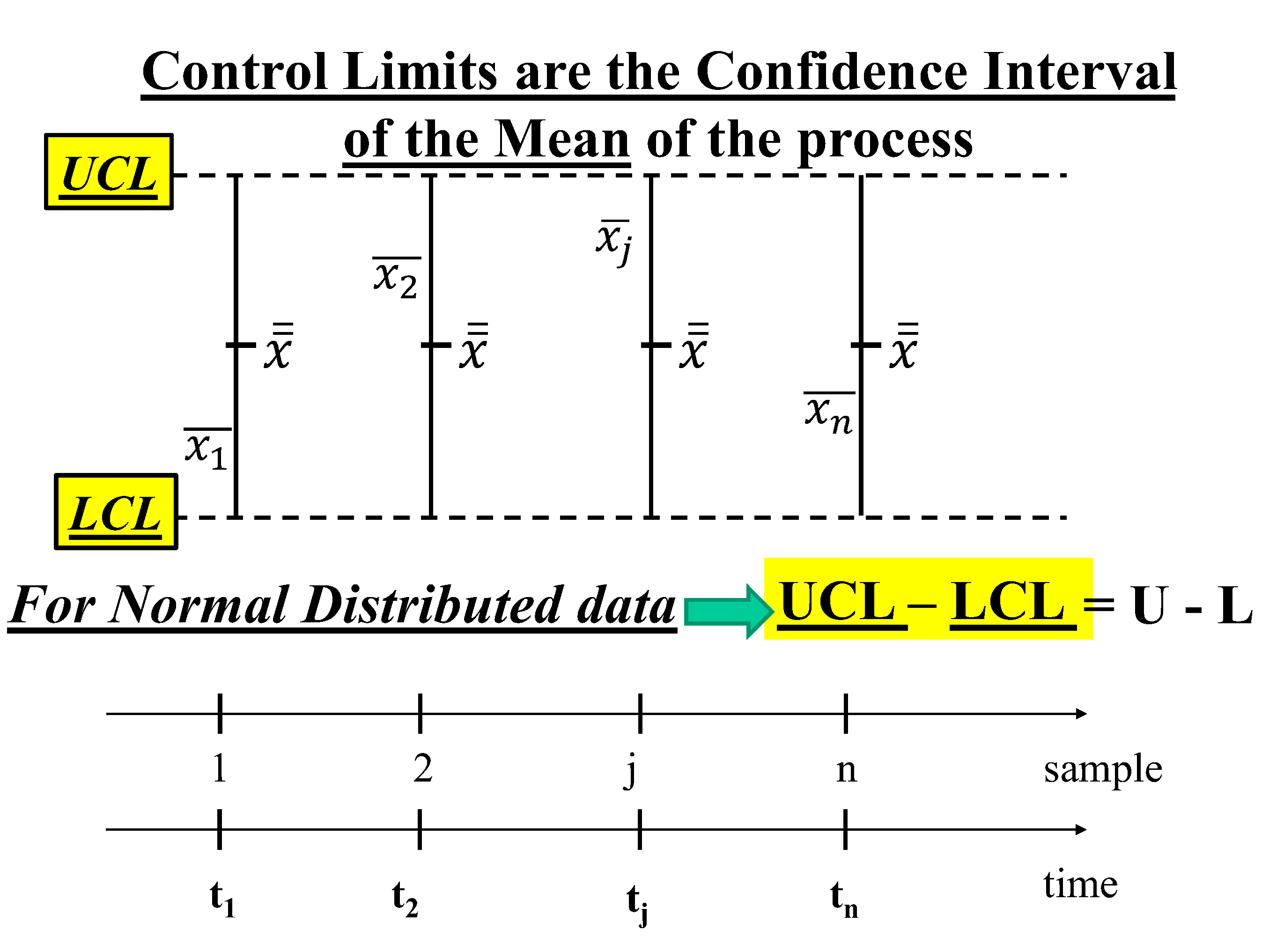

Shewhart identified this approach,
L and U, on page 275 of
[19]
where he states:
“For the most part, however, we
never know [this is the symbols of Shewhart
for our ] in sufficient detail to set up
such limit… We usually chose a symmetrical range characterised by
limits symmetrically spaced in reference to . Tchebycheff’s Theorem tells us
that the probability P that an observed value of will lie within these symmetric
limits so long as the quality standard is maintained satisfies the inequality
P>1-1/t2. We are still faced with the choice of t. Experience
indicated that t=3 seems to be an acceptable economic value”. See the excerpts
3,…
The Tchebycheff Inequality
: IF the RV X is arbitrary with density f(x) and finite variance
THEN we have the probability
, where
. This is a “Probabilistic
Theorem”.
It can be transferred into Statistics.
Let’s suppose that we want to determine experimentally the unknown mean
within a “stated error
ε
”. From the
above (Probabilistic) Inequality we have
; IF
THEN the event
is “very probable” in an
experiment: this means that the observed value
of the RV X can be written as
and hence
. In other words, using
as an estimate of
we commit an error that “most
likely” does not exceed
. IF, on the contrary,
, we need n data in order to write
, where
is the RV “mean”; hence we can
derive
., where
is the “empirical mean” computed
from the data. In other words, using
as an estimate of
we commit an error that “most
likely” does not exceed
. See the excerpts 3, 3a, 3b.
Notice
that, when we write
, we consider the Confidence
Interval CI
[6–21,25–33]
, and no longer the Probability Interval PI
[6–21,25–33]
.
These statistical concepts are
very important for our purpose when we consider the Control Charts, especially the Individual CCs, I-CC.
Notice
that the error made by several authors
[4,5,24]
is generated by lack of
knowledge of the difference between PI and CI
[6–21,25–33]
: they think wrongly
that CI=PI, a diffused disease
[4,5,24]
! They should study some of the books/papers
[6–21,25–33]
and remember the
Deming statements (excerpt 2).
The Deming statements are
important for Quality. Managers, scholars; the professors must learn Logic,
Design of Experiments and Statistical Thinking to draw good decisions. The
authors must, as well. Quality must be their number one objective: they must learn
Quality methods as well, using Intellectual Honesty
[1,2,6–21,25–33]
. Using (4), those
authors do not extract the maximum information from the data in the
Process Control. To extract the maximum information from the data
one needs statistical valid Methods
[1,2,6–21,25–33]
.
As you can find in any good book
or paper [6–21,25–33]
there is a strict relationship between CI and Test Of Hypothesis, known also as
Null Hypothesis Significance
Testing Procedure (NHSTP). In Hypothesis Testing, the experimenter wants to assess if a “thought” value of a
parameter of a distribution is confirmed (or rejected) by the collected data:
for example, for the mean μ (parameter) of the Normal
(x|
) density,
he sets the “null hypothesis” H
0={μ=μ
0} and the probability P=α of being wrong if he decides that the “null
hypothesis” H
0 is true, when actually it is opposite: H
0
is wrong. We analyse the observed sample D={x
1,
x
2, …, x
n} and we compute the empirical (observed)
mean
and the empirical (observed)
standard deviation
hence, we define the Acceptance
interval, which is the CI
Notice that the interval (for the
Normal model) [see the appendix B]
is the Probability Interval such
that
.
A fundamental reflection is
in order
: the formulae (5) and (6) tempt the
unwise guy to think that he can get the Acceptance interval, which is the
CI
[1–23]
, by
substituting the assumed values
of the parameters with the empirical
(observed) mean
and standard deviation
.
This
trick is valid only for the Normal distribution
.
More ideas about this can be found
in
[34–57]
.
In the field of Control Charts, following Shewhart, instead of the formula
(5), we use (7)
where the value
of the t distribution is
substituted by the value
of the Normal distribution,
actually
=3, and a coefficient
is used to make “unbiased” the
estimate of the standard deviation, computed from the information given by the
sample.
Actually, Shewhart does not use
the coefficient
is as you can see from page 294
of Shewhart book (1931), where
is the “Grand Mean”, computed
from D [named here empirical (observed) mean
],
is “estimated standard of each
sample” (named here s, with sample size n=20, in excerpt 3)
Excerpt 3
.
From Shewhart book (1931), on page 294.

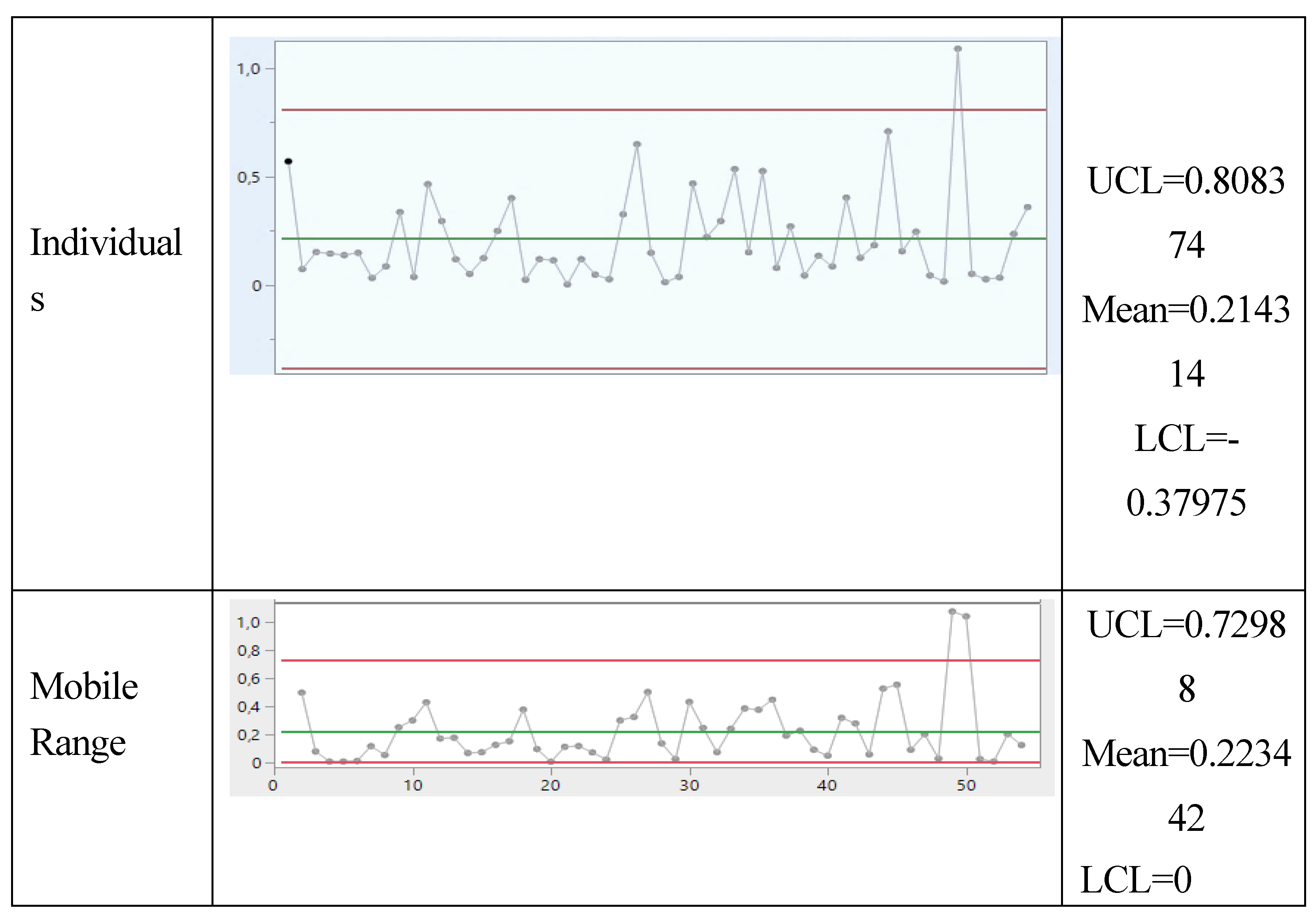

The application of these ideas in

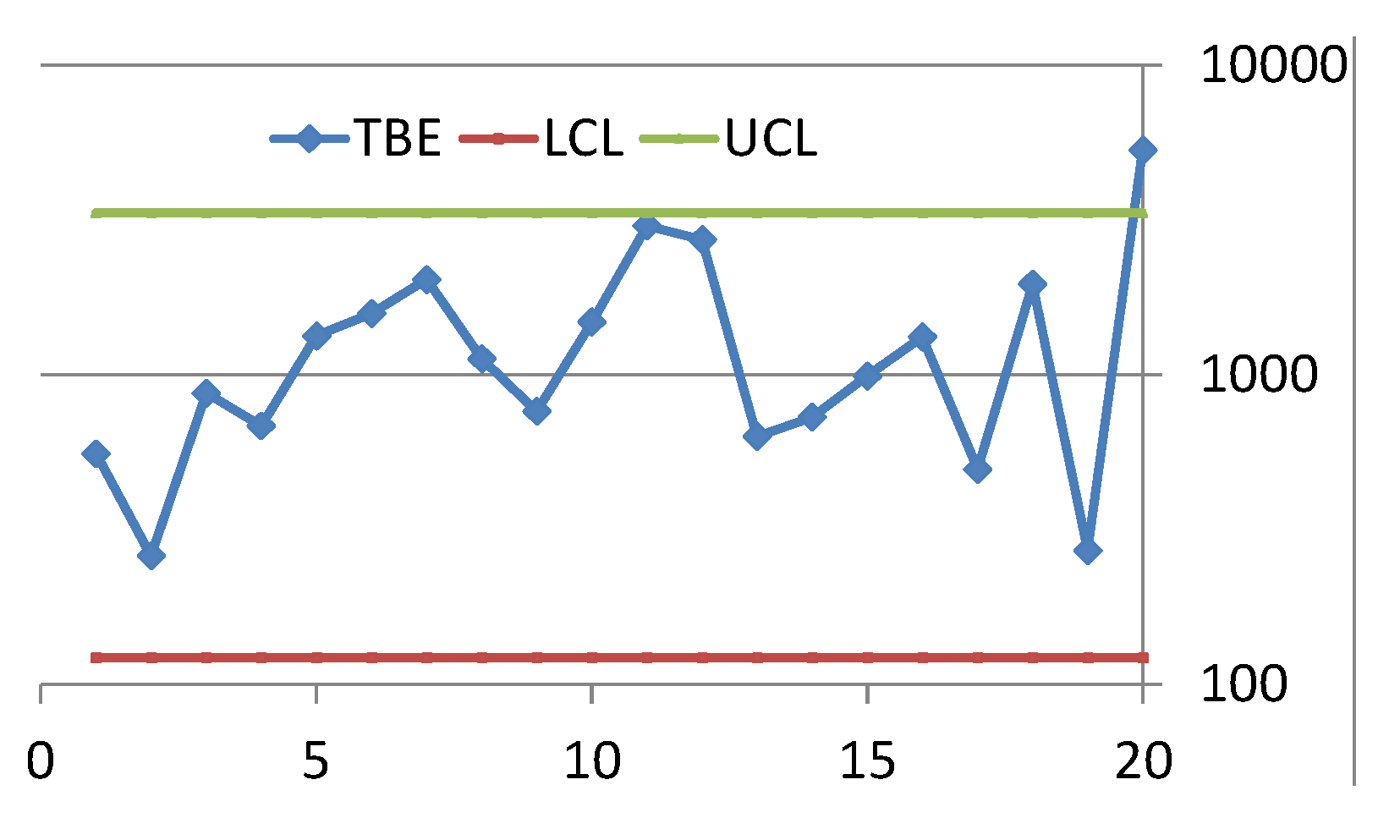

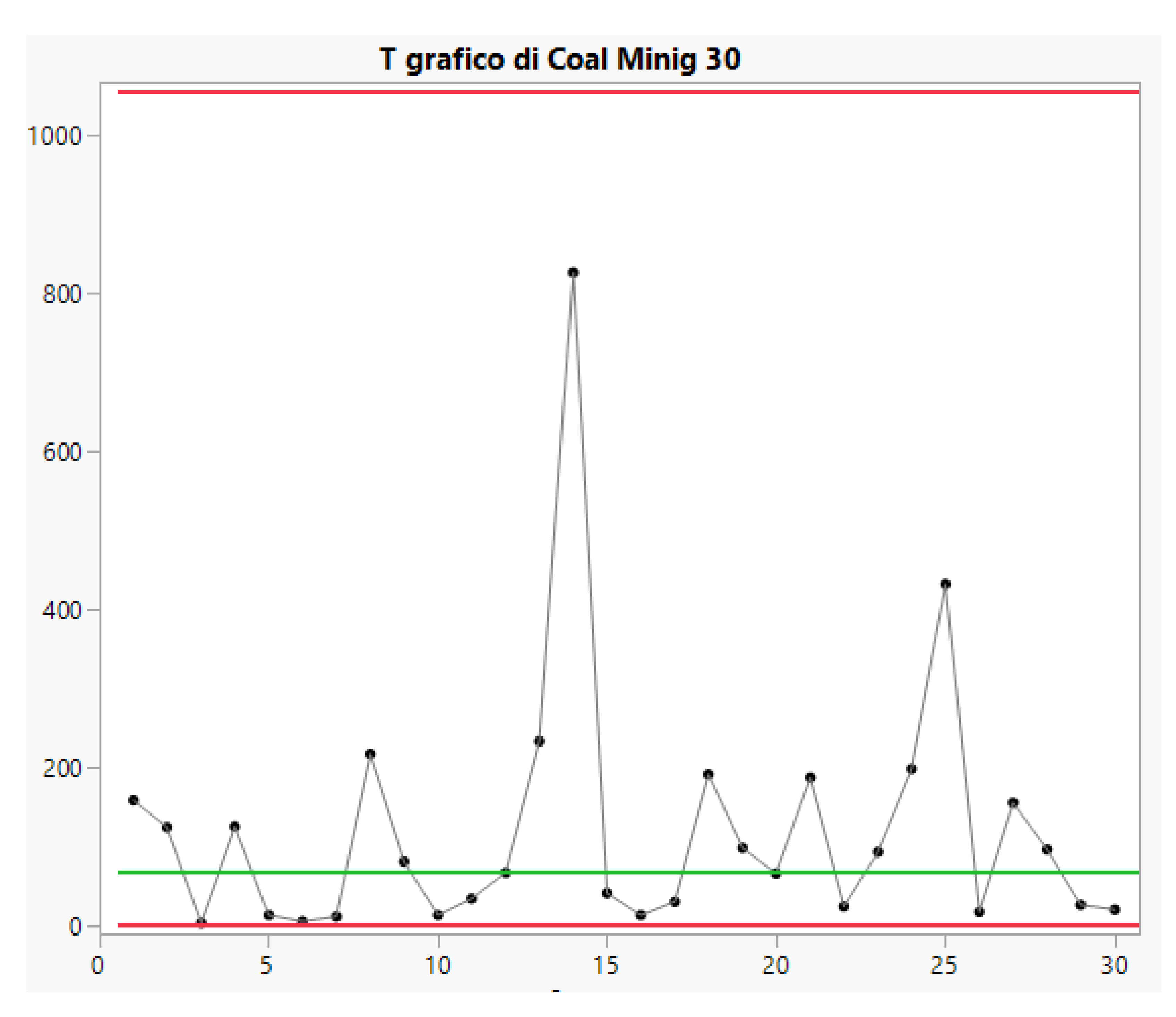

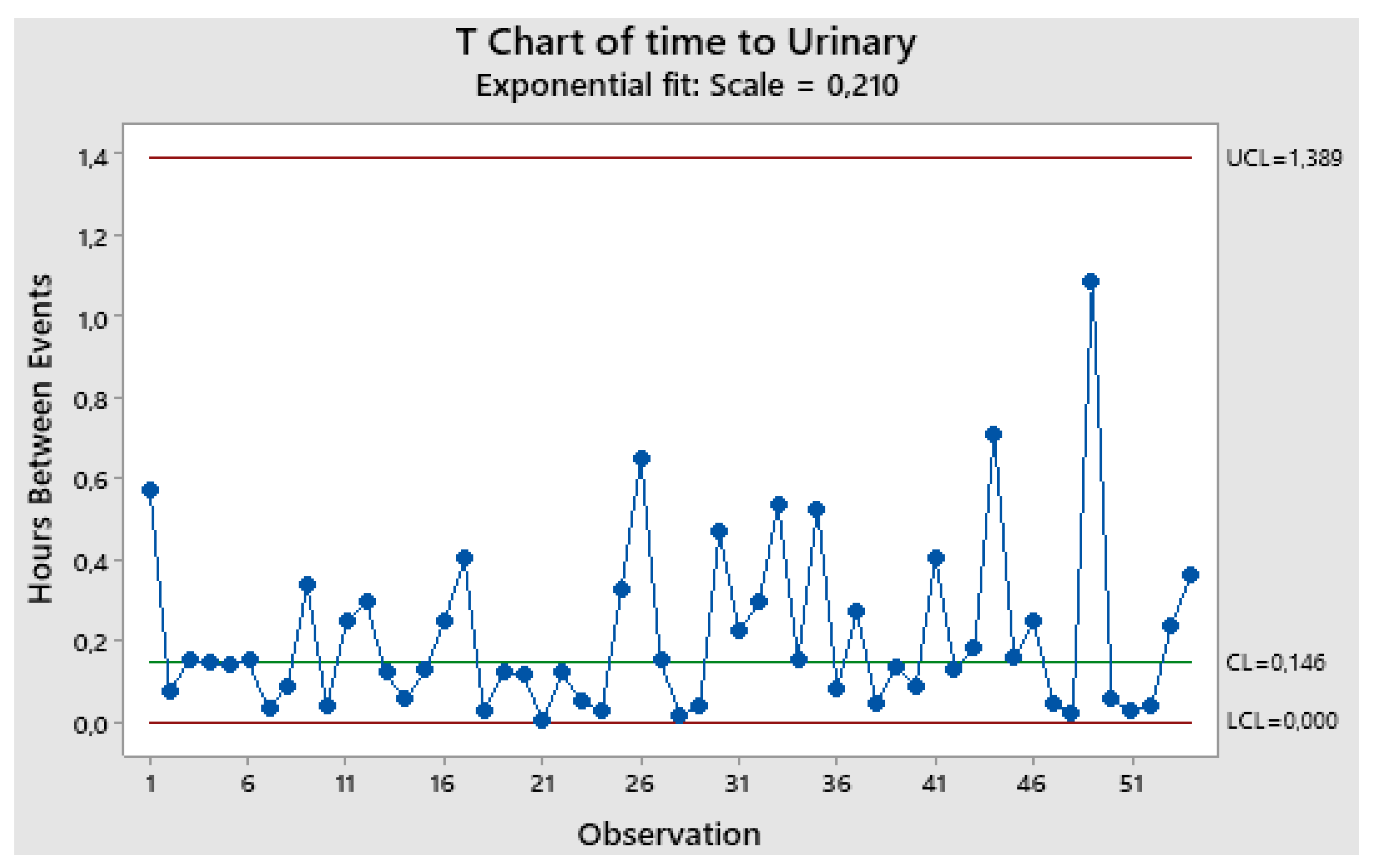

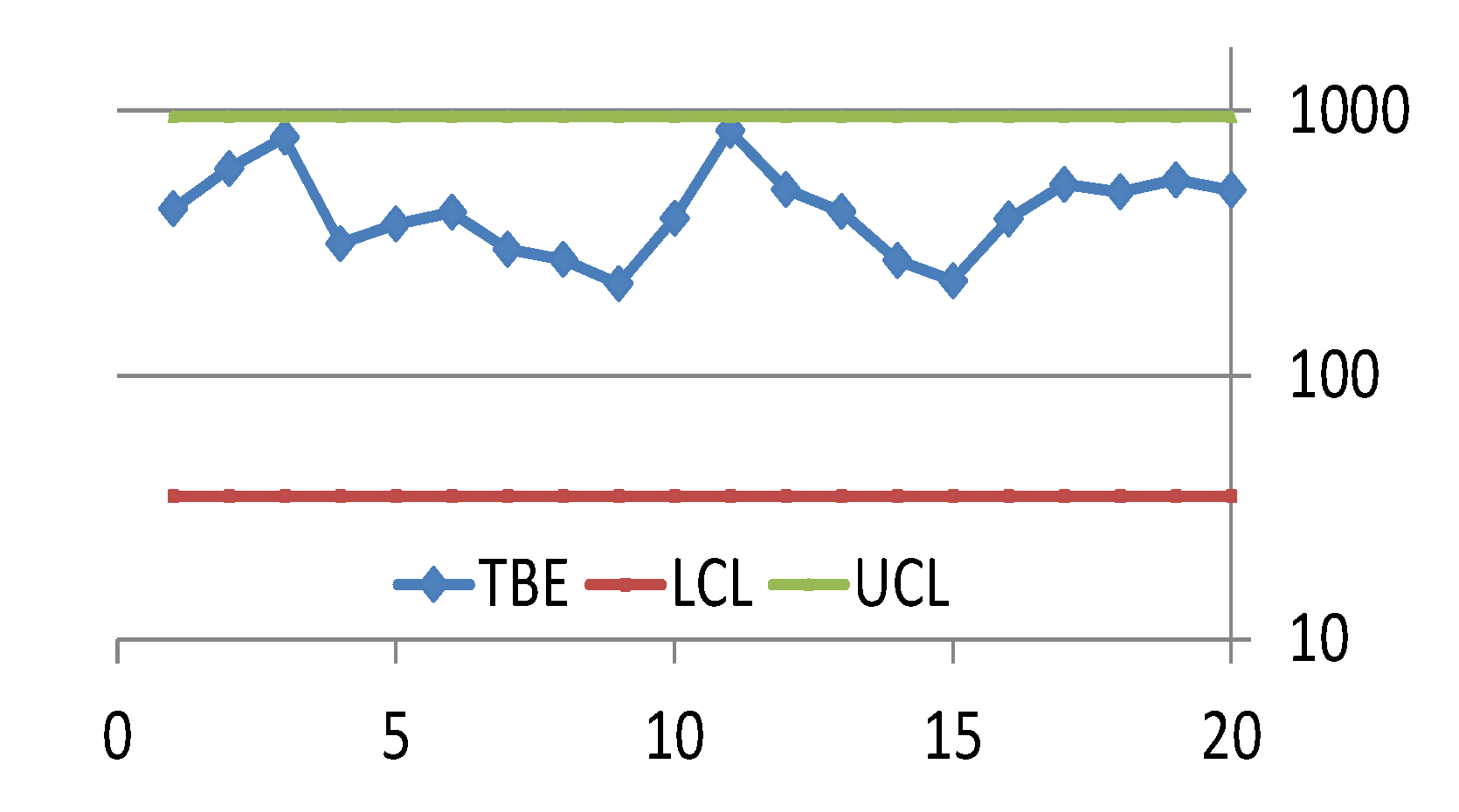

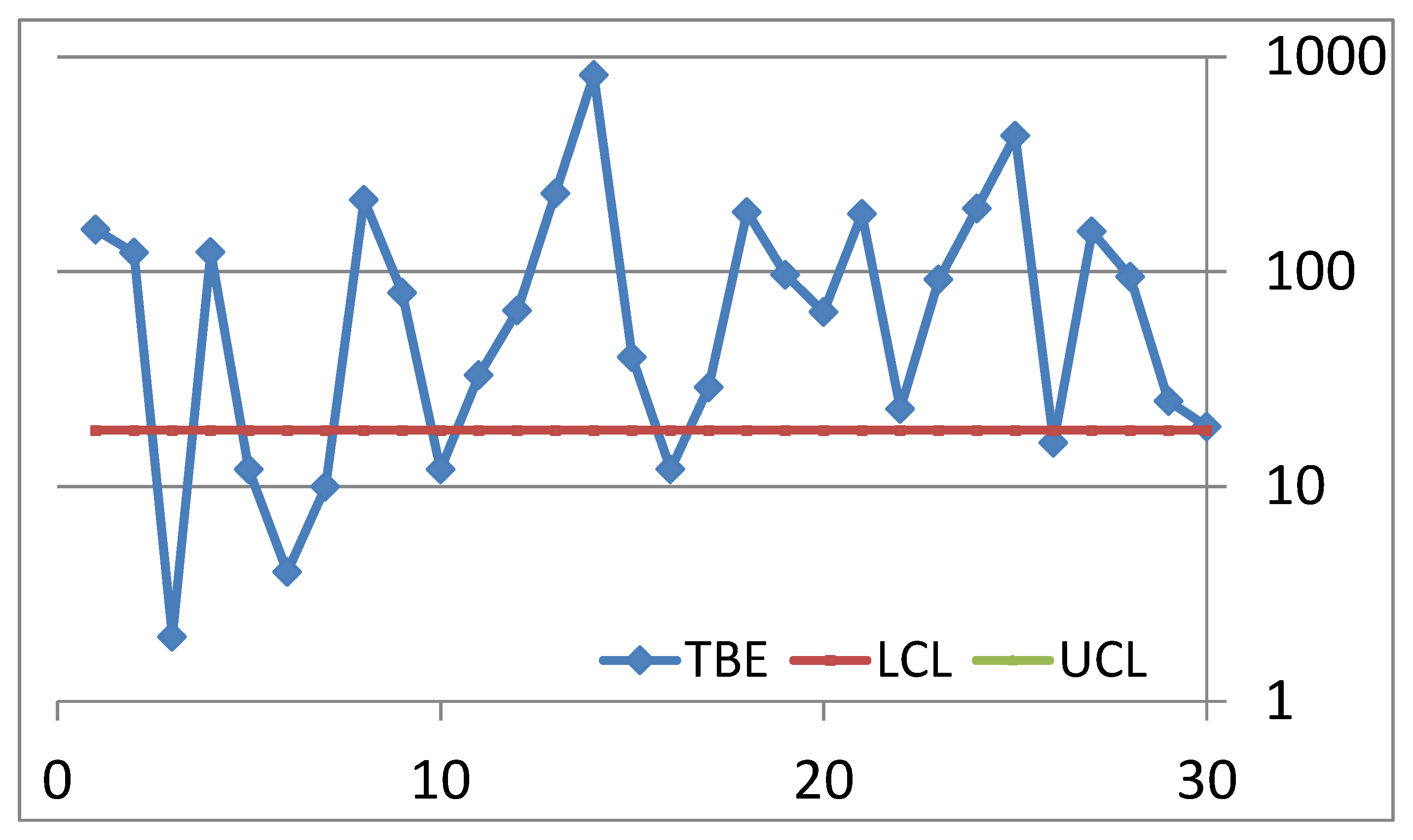

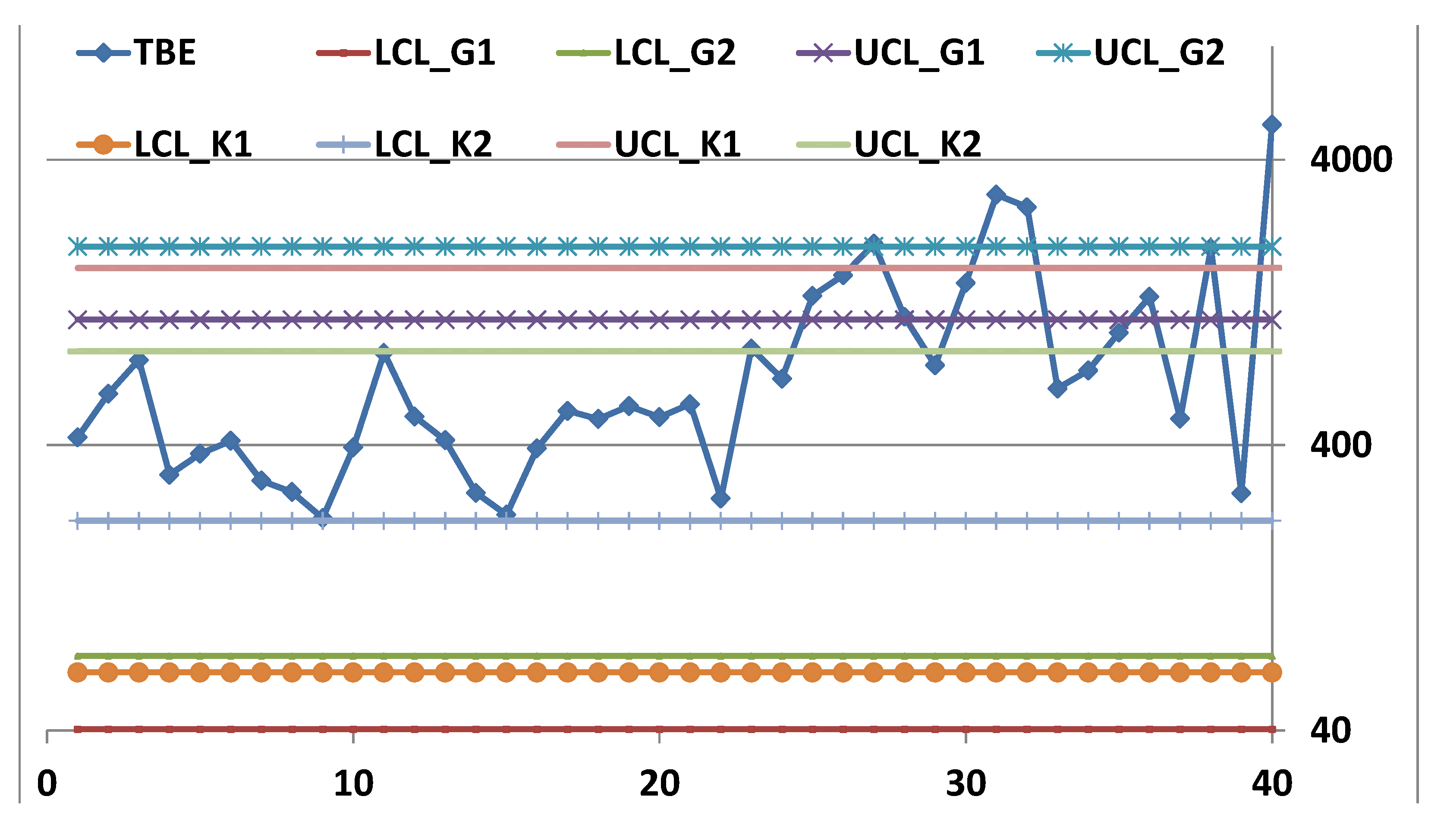

the Individual CCs can be seen in the
Appendix
A
, in the
Figure A1
: the standard deviation is derived from the Mobile Range (which is
exponentially distributed as the original UTI data). The formula in the excerpt
3 tells us that the process is OOC (Out Of Control).
2.2. ControlCharts for Process Management
Statistical Process Management
(SPM) entails Statistical Theory and tools used for monitoring any type of
processes, industrial or not. The Control Charts
(CCs) are the tool used for monitoring a process, to assess its two states: the
first, when the process, named IC (In Control), operates under the common
causes of variation (variation is always naturally present in any
phenomenon) and the second, named OOC (Out Of Control), when the
process operates under some assignable causes of variation. The
CCs, using the observed data, allow us to decide if the process is IC or OOC.
CCs are a statistical test of hypothesis for the process null hypothesis H0={IC}
versus the alternative hypothesis H1={OOC}. Control Charts were very considered by Deming
[9,10]
and Juran
[12]
after Shewhart invention
[19,20]
.
We start with Shewhart ideas (see
the excerpts 3, 3a and 3b).
In the excerpts, is the (experimental) “Grand Mean”, computed from
D (we, on the contrary, use the symbol ), is the (experimental) “estimated standard of each
sample” (we, on the contrary, use the symbol s, with sample size n=20, in
excerpts 3a, 3b), is the “estimated mean standard deviation of all
the samples” (we, on the contrary, use the symbol ).
Excerpt 3a. From Shewhart book
(1931), on page 89.
On page 95, he also states that
Excerpt 3b. From Shewhart book
(1931), on page 294.
So, we clearly see that Shewhart,
the inventor of the CCs, used the data to compute the Control Limits,
LCL (Lower Control Limit) and UCL (Upper Control Limit) both for the mean
(the 1st parameter of
the Normal pdf) and for
(the 2nd parameter of
the Normal pdf). They are considered the limits comprising 0.9973n of the
observed data. Similar ideas can be found in
[5–21,25–42]
(with Rozanov, 1975, we see the idea that CCs can be viewed as a
Stochastic Process).
We invite the readers to consider
that if one assumes that the process is In Control (IC) and if he
knows the parameters of the distribution he can test if the assumed known
values of the parameters are confirmed or disproved by the data, then he
does not need the Control Charts; it is
sufficient to use NHSTP! (see App. B)
Remember the ideas in the previous
section and compare Excerpts 3, 3a, 3b (where LCL, UCL depend on the data)
with the following Excerpt 4 (where LCL, UCL depend on the Random Variables)
and appreciate the profound “logic” difference: this is the cause of the many
errors in the CCs for TBE [Time Between Events (see
[4,5,24]
).
The same type
of arguments are used in another paper
[4]
JQT
, 2017
where the data are Erlang distributed with
λ
0
is the
scale parameter and the Control Limits LCL and UCL are defined [copying Xie et
al.] erroneously as
Excerpt 4
.
From a paper in the “Garden…
[24]
”. Notice that one of the
authors wrote several papers….
The formulae, in the excerpt 4,
LCL
1 and UCL
1 are actually the Probability Limits (L
and U) of the Probability Interval PI in the formula (4), when
is the pdf of the Estimator T,
related to the Normal model F(x;
μ
,
σ
2
). Using
(4), those authors do not extract the maximum information from the data in
the Process Control. From the Theory
[6–36]
we derive that the interval L=
μ
Y
-3
σ
Y
------
μ
Y
+3
σ
Y
=U is the PI such that the RV Y=
and it is not the CI of the mean
μ
=
μ
Y
[as wrongly said in the Excerpt 4,
where actually (LCL1-----UCL1)=PI].
The same error is in other books
and papers (not shown here but the reader can see in
[21–24]
).
The data plotted in the CCs
[6–21,25–36]
(see the
Figure 2
) are the means
, determinations of the RVs
, i=1, 2, ..., n (n=number of the
samples) computed from the collected data of the i-th sample Di={xij,
j=1, 2, ..., k} (k=sample size)}, determinations of the RVs
at very close instants tij,
j=1, 2, ..., k. In other applications I-CC (see the
Figure 3
), the data plotted
are the Individual Data
, determinations of the Individual
Random Variables
, i=1, 2, ..., n (n=number of the
collected data), modelling the measurement process (MP) of the “Quality
Characteristic” of the product: this model is very general because it is able
to consider every distribution of the Random Process
, as we can see in the next
section. From the excerpts 3, 3a, 3b and formula (5) it is clear that Shewhart
was using the Normal distribution, as a consequence of the Central Limit
Theorem (CLT)
[6–20,26–36]
. In fact, he wrote on page 289 of his book
(1931) “… we saw that, no matter what the nature of the distribution
function of the quality is, the distribution of the arithmetic mean approaches
normality rapidly with increase in n (his n is our k), and in all
cases the expected value of means of samples of n (our k) is the same as
the expected value of the universe” (CLT in Excerpt 3, 3a, 3b).
and “grand mean”
Figure 2.
Control Limits LCLX----UCLX=L----U (Probability interval), for Normal data (Individuals xij, sample size k) “sample means”
Figure 2.
Control Limits LCLX----UCLX=L----U (Probability interval), for Normal data (Individuals xij, sample size k) “sample means”
Figure 3.
Individual Control Chart (sample size k=1). Control Limits LCL----UCL=L----U (Probability interval), for Normal data (Individuals xi) and “grand mean”
Figure 3.
Individual Control Chart (sample size k=1). Control Limits LCL----UCL=L----U (Probability interval), for Normal data (Individuals xi) and “grand mean”
Let k be the sample size; the RVs
are assumed to follow a normal
distribution and uncorrelated;
[ith rational
subgroup] is the mean of RVs IID
j=1, 2, ..., k, (k data sampled,
at very near times tij).
To show our way of dealing with
CCs we consider the process as a “stand-by system whose
transition times from a state to the subsequent one” are the collected data.
The lifetime of “stand-by system” is the sum of the lifetimes of each unit. The
process (modelled by a “stand-by …”) behaves as a Stochastic Process [25–33], that we can manage by the Reliability Integral Theory (RIT): see
the next section; this method is very general because it is able to consider
every distribution of .
If we assume that
is distributed as f(x)
[probability density function (pdf) of “transitions from a state to the
subsequent state” of a stand-by subsystem] the pdf of the (RV) mean
is, due the CLT (page 289 of 1931
Shewhart book),
[experimental mean
] with mean
and variance
.
is the “grand” mean and
is the “grand” variance: the pdf
of the (RV) grand mean
[experimental “grand” mean
]. In
Figure 2
we show the
determinations of the RVs
and of
.
When the process is Out Of Control (OOC, assignable
causes of variation, some of the means , estimated by the experimental means , are “statistically different)” from the others [6–21,25–36]. We can assess the OOC state of the
process via the Confidence Interval (provided by the Control Limits) with CL=0.9973;
see the Appendix B. Remember the trick
valid only for the Normal Distribution ….; consider the
PI, L=μY-3σY------μY+3σY=U;
putting in place of and in place of we get the CI of when the sample size k is considered for each , with CL=0.9973. The quantity is the mean of the standard deviations of each
sample. This allows us to compare each (subsystem) mean , q=1,2, …, n, to any other (subsystem) mean r=1,2, …, n, and to the (Stand-by system) grand
mean . If two of them are different, the process is
classified as OOC. The quantities and are the Control Limits of the CC. When the Ranges
Ri=max(xij)-min(xij) are considered for each
sample we have , and , U, where is the “mean range” and the coefficients A2,
D3, D4 are tabulated and depend on the sample size k [6–21,25–36].
See the Appendix B:
it is important for understanding our ideas.
The interval LCLX-------UCLX
is the “Confidence Interval” with “Confidence Level” CL=1-α=0.9973 for the unknown mean of the Stochastic Process X(t) [25–36]. The interval LCLR----------UCLR
is the “Confidence Interval” with “Confidence Level” CL=1-α=0.9973 for the unknown Range of the
Stochastic Process X(t) [25–36].
Notice that, ONLY for normally
distributed data, the length of the Control Interval (UCLX-LCLX,
which is the Confidence Interval) equals the length of the Probability
Interval, PI (U-L): UCLX-LCLX=U-L.
The error highlighted, i.e. the confusion
between the Probability Interval and the Control Limits (Confidence
Interval!) has no consequences for decisions when the data are Normally
distributed, as considered by Shewhart. On the contrary, it has BIG
consequences for decisions WHEN the data are Non-Normally distributed
[4,5,24]
.
We think that the paper “Quality
of Methods for Quality is important”, [1]
appreciated and mentioned by J. Juran at the plenary session
of the EOQC (European Organization for Quality Control) Conference (1989),
should be considered and meditated.
2.3. Statistics and RIT
We are going to present the fundamental concepts
about RIT (Reliability Integral Theory) that we use for computing the Control
Limits of CCs. Since in the example chosen, 4 data will be “compounded” we use
a “4 units Stand-by system”, depicted by 5 states (Figure 4): 0 is the state with all units
not-failed; 1 is the state with the first unit failed; 2 is the state with the
second unit failed; and so on, until the system enters the state 5 where all
the 4 units are failed (down state, in yellow): any transition provides a datum
to be used for the computations. RIT can be found in the author’s books…

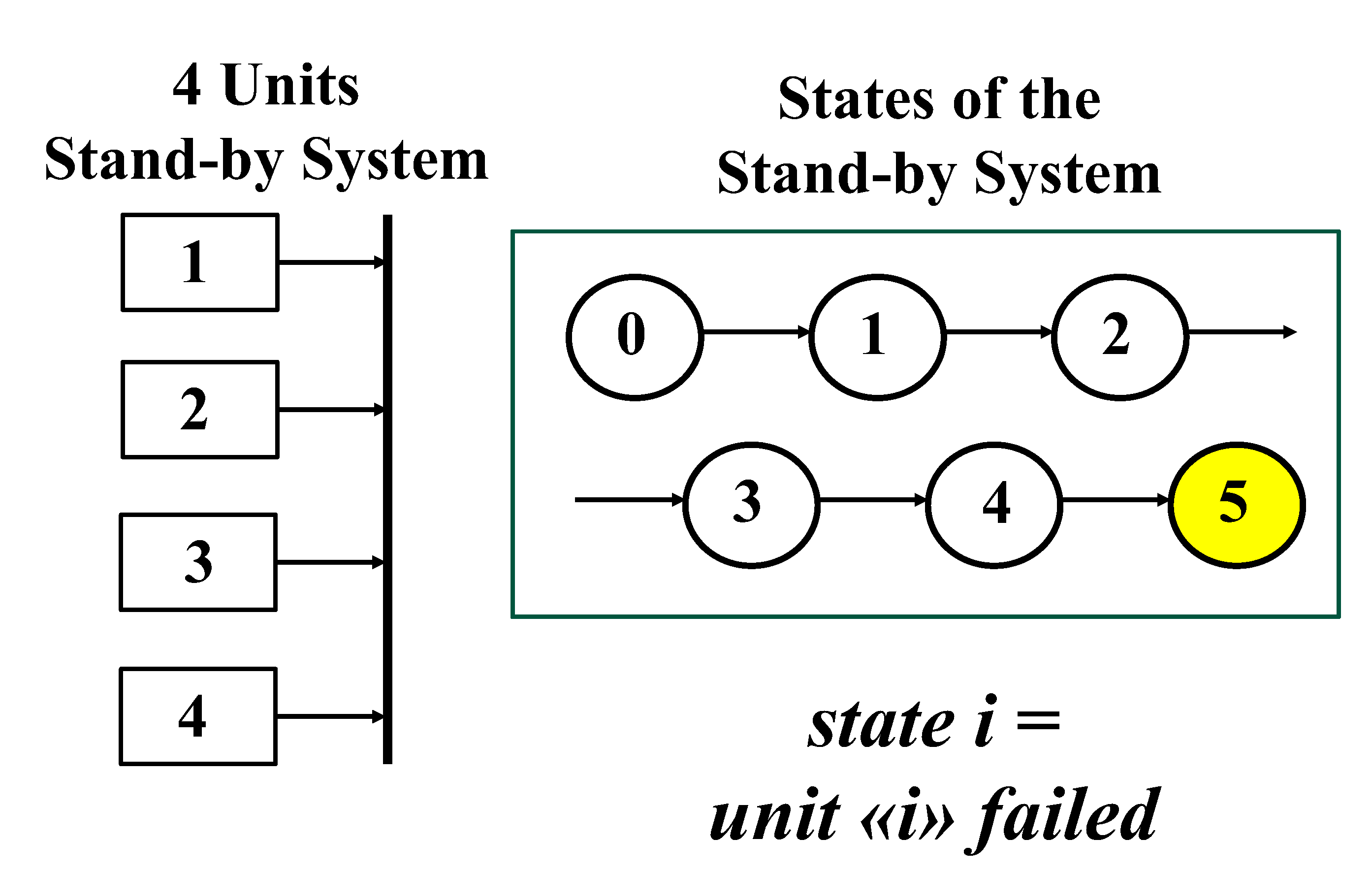

Figure 4.
A “4 units Stand-by system” and its states.
Figure 4.
A “4 units Stand-by system” and its states.
RIT can be used for parameters estimation and
Confidence Intervals (CI), (Galetto 1981, 1982, 1995, 2010, 2015, 2016), in
particular for Control Charts (Deming, 1986,
1997, Shewhart 1931, 1936, Galetto 2004, 2006, 2015). In fact, any Statistical
or Reliability Test can be depicted by an “Associated Stand-by System” [25–36] whose transitions are ruled by the kernels bk,j(s);
we write the fundamental system of integral equations for the reliability
tests, whose duration t is related to interval 0-----t; the
collected data tj can be viewed as the times of the various failures
(of the units comprising the System) [t0=0 is the start of the test,
t is the end of the test and g is the number of the data (4 in the Figure 4)]
Firstly, we assume that the kernel is the pdf of the exponential distribution (|), where is the failure rate of each unit and : is the MTTF of each unit. We state that is the probability that the stand-by system does
not enter the state g (5 in Figure 4), at
time t, when it starts in the state j (0, 1, …, 4) at time tj, is the probability that the system does not leave
the state j, is the probability that the system makes the
transition j→j+1, in the interval s-----s+ds.
The system reliability
is the solution of the
mathematical system of the Integral Equations (8)
With

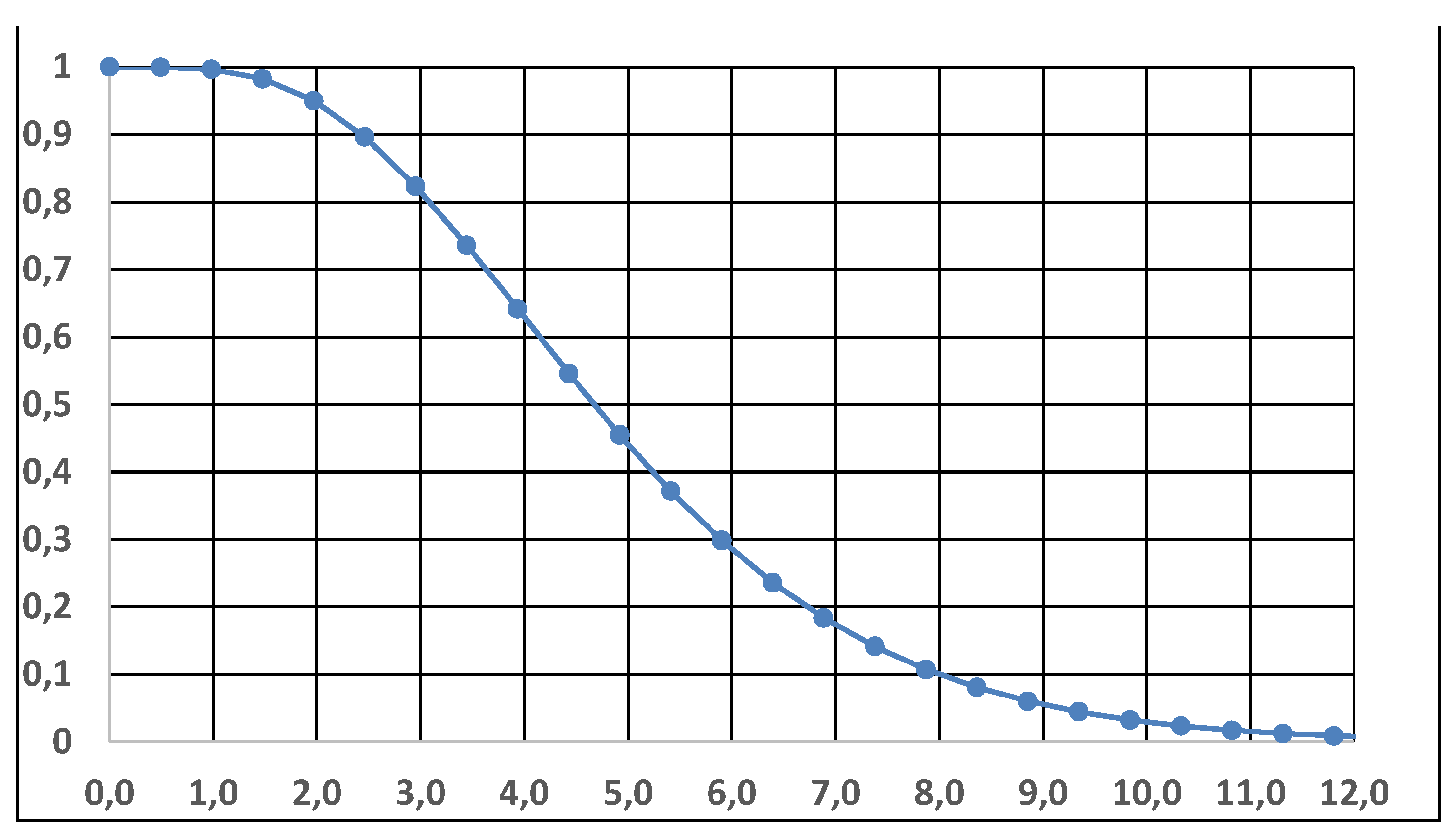

we obtain the solution (see Figure 5, putting the Mean Time To Failure
MTTF=θ=123 days,
)
The reliability system (8) can be written in matrix
form,
At the end of the reliability test, at time t, we
know the data (the times of the transitions tj) and the “observed”
empirical sample D={x1, x2, …, xg},
where xj=tj – tj-1 is the length between the
transitions; the transition instants are tj = tj-1 + xj
giving the “observed” transition sample D*={t1, t2, …, tg-1,
tg, t=end of the test}
(times of the transitions tj).
We consider now that we want to estimate the unknown MTTF=θ=1/λ of each item comprising the “associated” stand-by system [
24,
25,
26,
27,
28,
29,
30]: each datum is a measurement from the exponential pdf; we compute the determinant
of the integral system (9), where
is the “Total Time on Test”
[
in the
Figure 5]: the “Associated Stand-by System” [
25,
26,
27,
28,
29,
30,
31,
32,
33] in the Statistics books provides the pdf of the sum of the RV X
i of the “
observed”
empirical sample D={x
1, x
2, …, x
g}. At the end time t of the test, the integral equations, constrained by the
constraintD*, provide the equation
It is important to notice that, in the case of exponential distribution [
11,
12,
13,
14,
15,
16,
25,
26,
27,
28,
29,
30,
31,
32,
33,
34,
35,
36], it is
exactly the same result as the one provided by the MLM Maximum Likelihood Method.
If the kernel is the pdf (|) the data are normally distributed, , with sample size n, then we get the usual estimator such that .
of a “4 units Stand-by system” with MTTF=θ=123 days; is the total time on test of the 4 units. To compute the CI (with CL=0.8), find the abscissas of the intersections at and ….
The same happens with any other distribution provided that we write the kernel .
The reliability function
, [formula (8)], with the parameter
, of the “Associated Stand-by System” provides the
Operating Characteristic Curve (OC Curve, reliability of the system) [
6,
7,
8,
9,
10,
11,
12,
13,
14,
15,
16,
17,
18,
19,
20,
21,
22,
23,
24,
25,
26,
27,
28,
29,
30,
31,
32,
33,
34,
35,
36] and allows to find the Confidence Limits (
Lower and
Upper) of the “unknown” mean
, to be estimated, for any type of distribution (Exponential, Weibull, Rayleigh, Normal, Gamma, …); by solving, with unknown
, the two equations
(
|
)
; we get the two values (
,
) such that
where is the (computed) “total of the length of the transitions xi=tj - tj-1 data of the empirical sampleD” and CL= is the Confidence Level. CI=-------- is the Confidence Interval: and .
For example, with

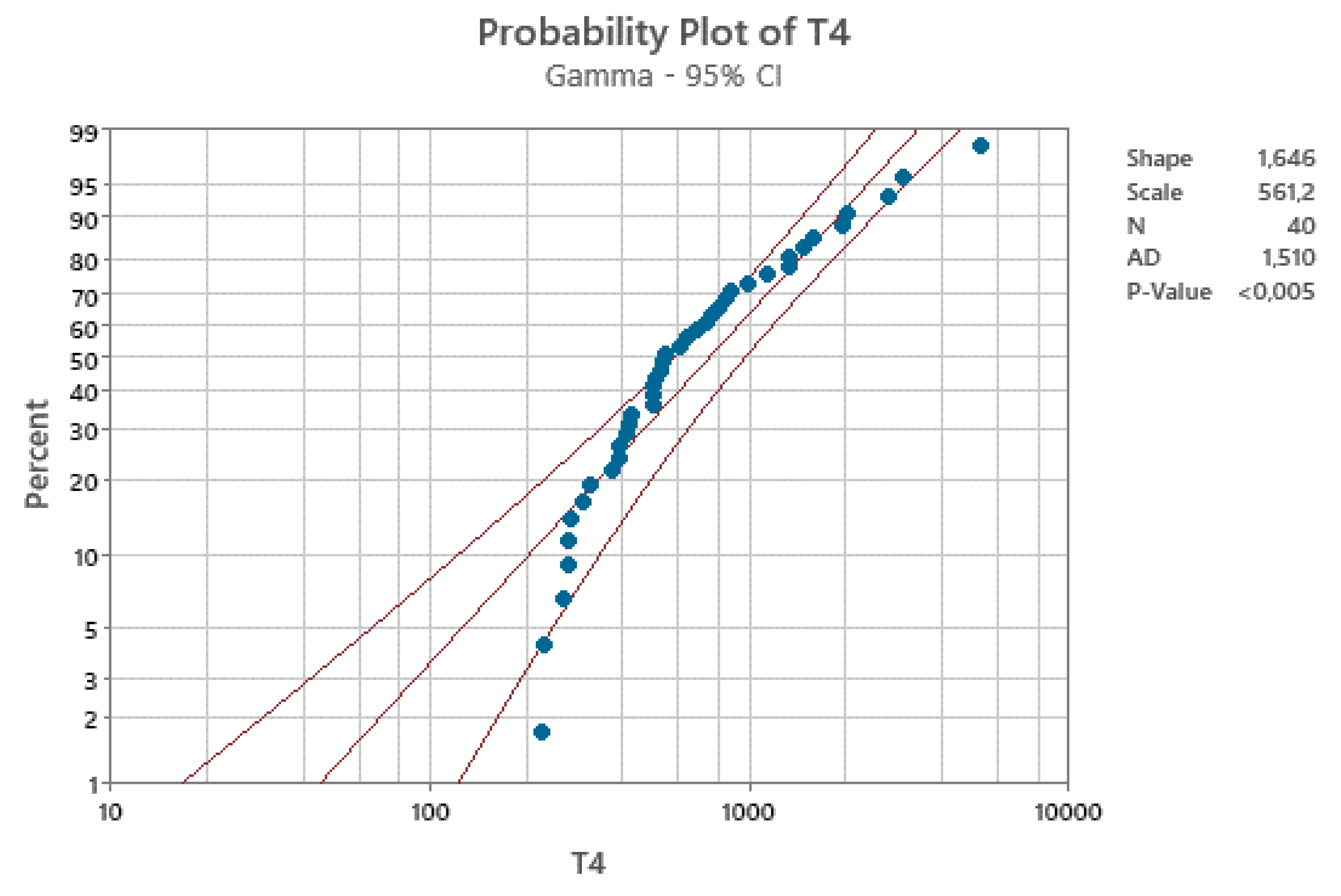

Figure 5, we can derive
and
, with CL=0.8. It is quite interesting that the book [
14] Meeker et al., “
Statistical Intervals: A Guide for Practitioners and Researchers”, John Wiley & Sons (2017) use the same ideas of FG (shown in the formula 11) for computing the CI; the only difference is that the author FG defined the procedure in 1982 [
26], 35 years before Meeker et al.
2.4. ControlCharts for TBE Data. Some Ideas for Phase I Analysis
Let’s consider now TBE (Time Between Event) data,
exponentially or Weibull distributed. Quite a lot of authors (in the “
Garden … [
24]”)
compute wrongly the Control Limits of these CCs.
The formulae, shown in the section “ControlCharts for Process Management”, are based on the Normal distribution (thanks to the CLT; see the excerpts 3, 3a and 3b); unfortunately, they are used also for NON_normal data (e.g. see formulae (1)): for that, sometimes, the NON_normal data are transformed “with suitable transformations” in order to “produce Normal data” and to apply those formulae (above) [e.g. Montgomery in his book].
Sometimes we have few data and then we use the so called “Individual ControlCharts” I-CC. The I-CCs are very much used for exponentially (or Weibull) distributed data: they are also named “rare events ControlCharts for TBE (Time Between Events) data”, I-CC_TBE.
The Jarret data (1979) are used also in the paper (
found online, 2024, March 1) [
4] (Kumar, Chakraborti et al. with various presence in the “
Garden … [
24]”) who decided to consider the paper [
5] (Zhang et al. also present in the “
Garden …]”): they use the first 30 observed time intervals as phase 1 and start the monitoring at m = 31. You find the original data in the
Table 1 in the paper [
3]; moreover, for the benefit of the readers we provide them in the section 3 “Results”.
It is a very good example for understanding better the problem and the consequences of the difference between PI (Probability Intervals) and the Control Limits, using RIT.
Let’s see what the authors say: Kumar, Chakraborti et al. , Journal of Quality Technology, 2016, present the case by writing (highlight due to FG):
5. An Illustrative Example
In this Section, we use the data from Table 6 of Zhang et al. (2006) (see also Jarrett 1979) in order to illustrate the application of the proposed charting schemes. The data consist of the time intervals in days between explosions in coal mines (i.e., the events) from 15 March 1981 to 22 March 1962 (190 observations in total) in Great Britain. As in Zhang et al. (2006), we consider the first m=30 observations to be from the in-control process, from which we estimate that (or equivalently, the mean TBE is approximately 123 days). In the sequel, we assume that this is the true in-control value . Since our numerical analysis showed that r=4 is the best choice we apply the t4-chart … Thus, the remaining 160 observations are first converted by accumulating a set of four consecutive failure times and the corresponding observations are shown in Table… These are the times until the fourth failure, and are used for monitoring the process in order to detect a change in the mean TBE; an increase (which means process improvement) or a decrease (process deterioration).
Excerpt 5. From Kumar, Chakraborti et al., “Journal of Quality Technology”, 2016.
In the paper of Zhang et al. (2006) we read:
The second example presented here uses real data taken from Jarrett (1979). The data set consists of time intervals in days between explosions in coal mines from March 15, 1851 to March 22, 1962. The data are reproduced in Table 6. We first establish the ARL-unbiased exponential chart with the first 30 observations using the proposed approach. The phase I analysis is presented in Table …. Then the established control limits are used to monitor the subsequent data, i.e., from number 31 to number 190. The resultant ARL-unbiased exponential chart for all the data is plotted in Fig…., where the dotted lines represent the estimated control limits which stop updating at point number 30 and the continuing straight lines represent the established control limits. It is revealed, surprisingly, that the mean of the time intervals between explosions remained constant for a very long period of time (about 40 years), and the accident rate only started to decrease sometime after the 125th explosion. There is an alarm at data point number 80 (value = 0), which is considered here a false alarm.
Excerpt 6. From Zhang et al. (2006), “IIE Transactions”.
Notice that both the papers [
4,
5] are (and were) present in the “
Garden … [
24]”.
Zhang et al., 2006, compute the Control Limits from the first 30 data and find LCL=0.268 and UCL=1013.9 (you can see them in their Table 7, that is “our” excerpt 11).
All the data [30+40 t4] are very interesting for our analysis; we recap the two important points, given by the authors (Kumar et al.):
… first m=30 observations to be from the in-control process, from which we estimate … the mean TBE approximately, 123 days; we name it θ0.
… we apply the t4-chart… Thus, … converted by accumulating a set of four consecutive failure times … the times until the fourth failure, used for monitoring the process to detect a change in the mean TBE.
The 3 authors (Kumar, Chakraborti et al.) state: “… the control limits … t4-chart are seen to be equal to LCL=63.95, UCL=1669.28 with CL (Centre Line)=451.79.”
Notice that the authors Zhang et al. and Kumar, Chakraborti et al. find different Control Limits to be used for monitoring the same process: a very interesting situation; the reason is that they use “different” statistics in Phase II.
The FG findings for the Phase I, using the first 30 data, compute different Control Limits with RIT: RIT solves the I-CC_TBE with
exponentially distributed data as those of
Table 1, considered by Zhang et al. and Kumar et al.
In the previous section, we computed the CI=-------- of the parameter , using the (subsample) “transition times durations”: =“total of the transition times durations (length of the transitions xi=tj - tj-1 data) in the empirical sample (subsample with n=4 only, as an example)” and Confidence Level CL=.
When we deal with a I-CC_TBE we compute the LCL and UCL of the mean θ through the
empirical mean of each transition, for the
n=30 data (
Phase I of Zhang et al. and Kumar et al.); we solve the two following equations (12) for the two unknown values LCL and UCL, for
of each item in the sample, similar to (11)
where now /n is the “mean, to be attributed, to the single lengths of the single transitions xi=tj-tj-1 data in the empirical sampleD with the Confidence Level CL=: and .

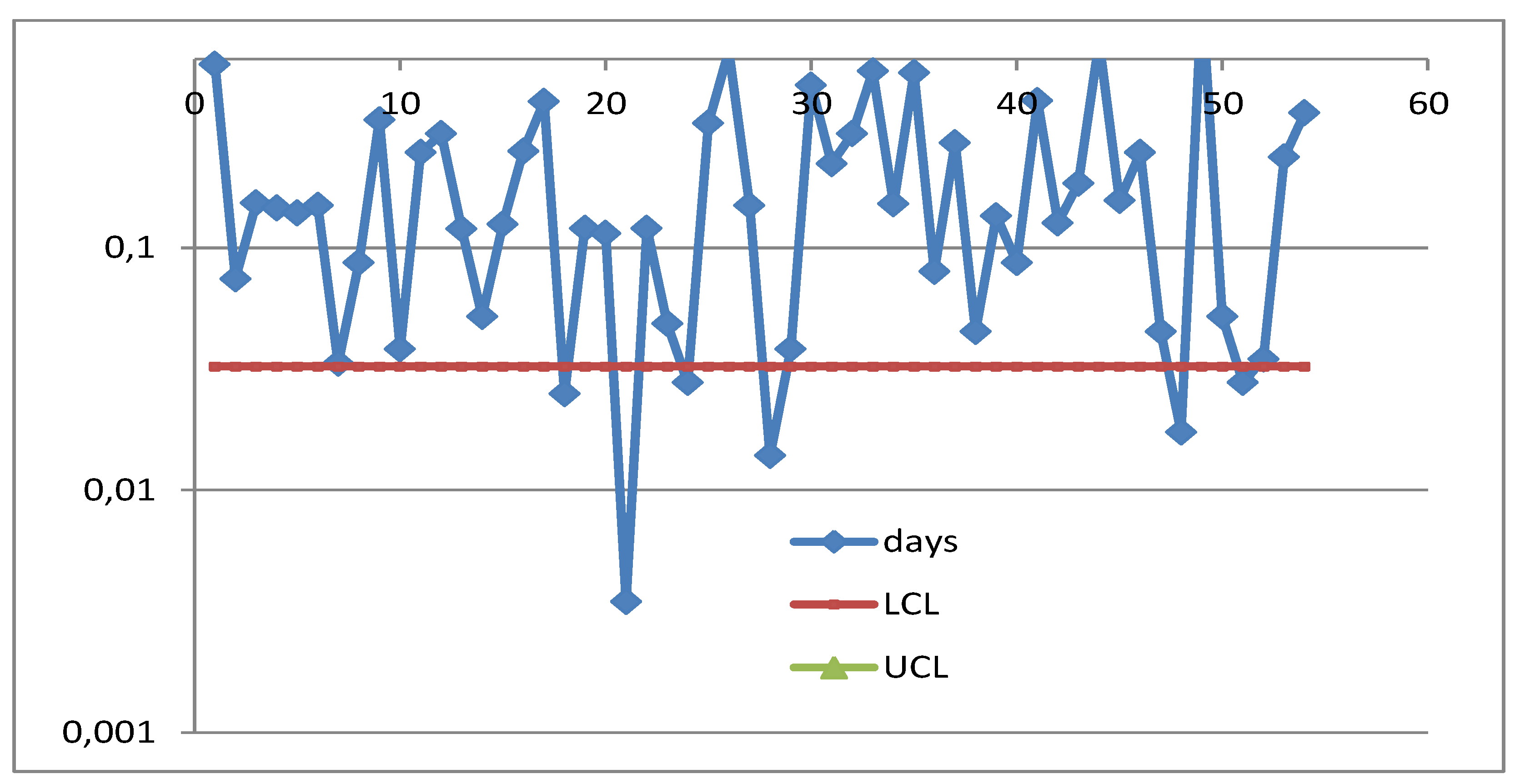

In the next sections we can see the Scientific Results found by a Scientific Theory (we anticipate them: the Control Limits are LCL=18.0 days and UCL=88039.3 days).
