Submitted:
14 March 2024
Posted:
14 March 2024
You are already at the latest version
Abstract

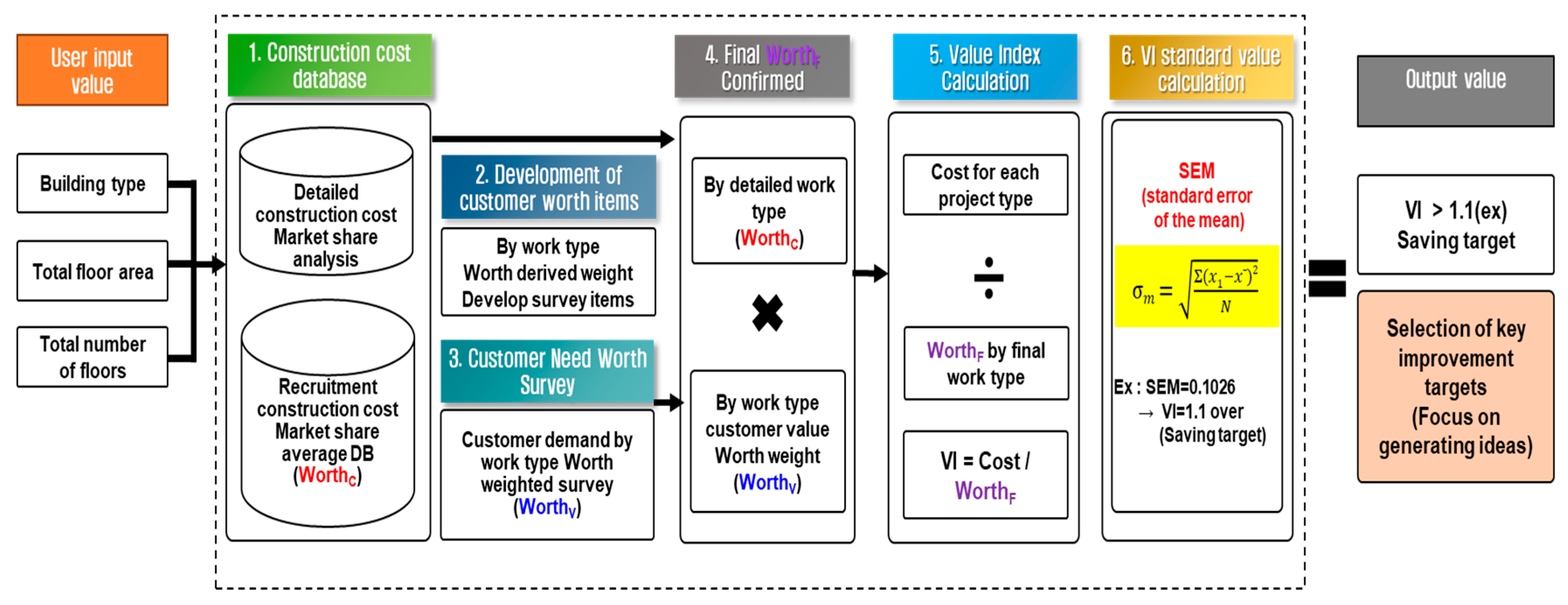

Keywords:
1. Introduction
1.1. Background and Purpose of Research
1.2. Scope and Method of Research
1.3. Analysis of Prior Research

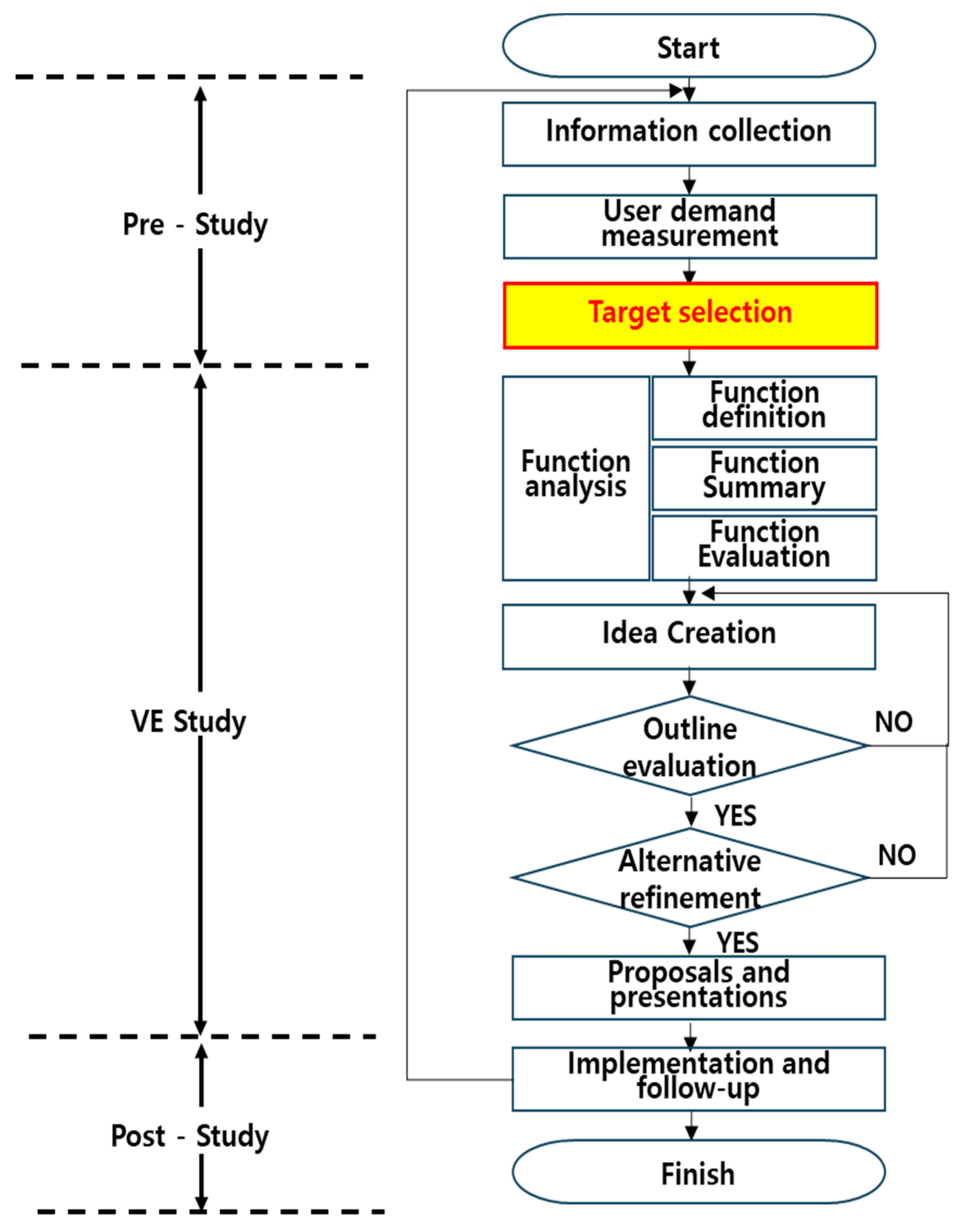

2. Theoretical Considerations of a Selection of VE Targets

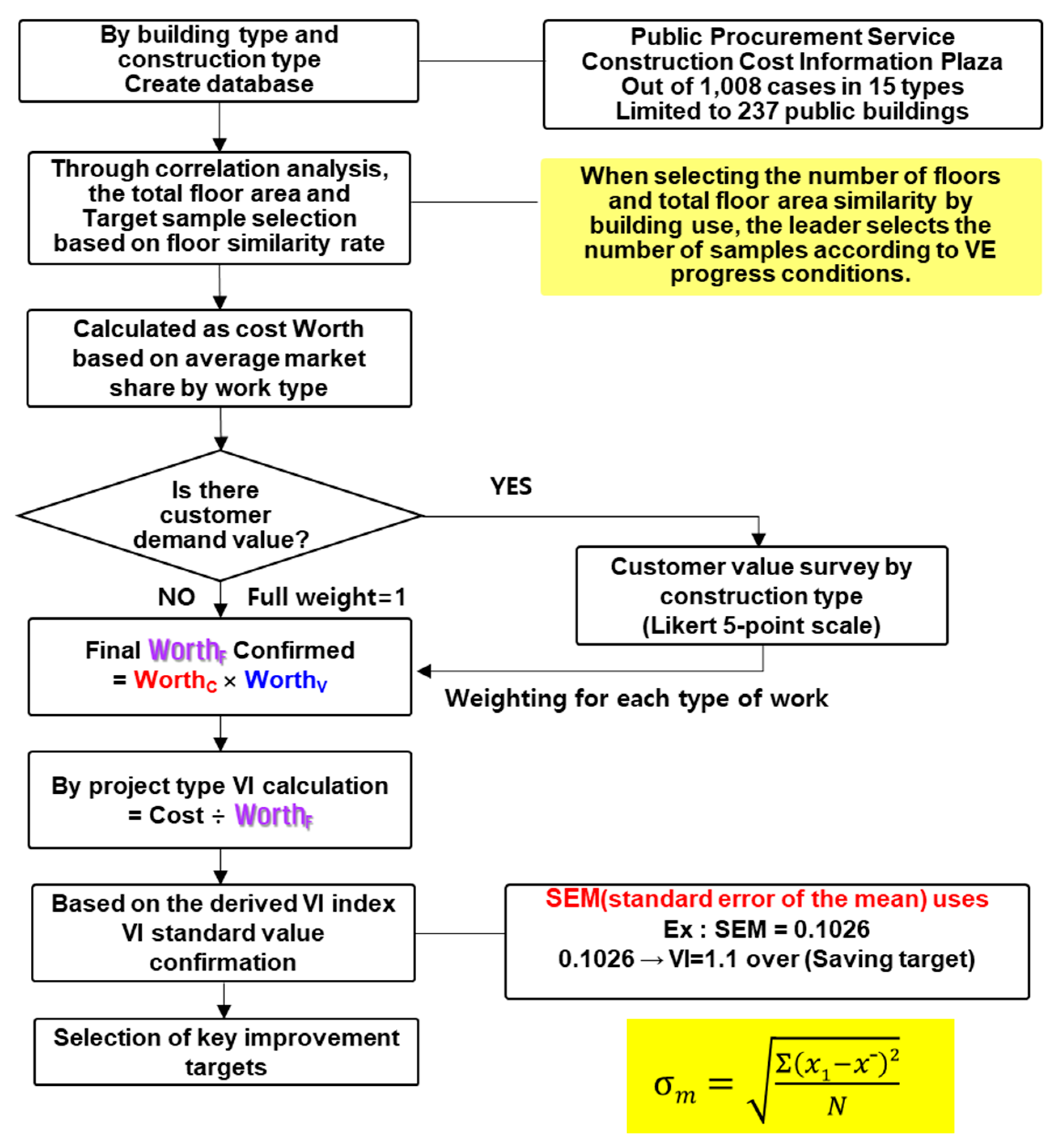

3. Research Methods
3.1. Data Analysis of Construction Cost Information Plaza Website
3.2. Estimating Cost WorthC
- WorthC : Cost by Detailed Construction Item Worth (Cost)
- WorthV : Customer Value by Detailed Construction Item Worth (Value)
- WorthF : Worth by Detailed Construction Item (Final) = WorthC × WorthV Weight
3.3. Calculating the Customer Value WorthV
3.4. Derive the Final WorthF
3.5. Value Index (VI) Calculation
3.6. Derivation of Value Index (VI) Standard Value
3.7. Selection of Key Target Construction Types (Functions)
4. Model Validation
4.1. Selection of the Respective Project
4.2. Calculate the Cost of the Target Sample WorthC
4.3. Calculation of Customer Value WorthV and Final WorthF
4.4. Derivation of Value Index (VI) and Standard Value
4.5. Selection and Analysis of Key Target Categories (Functions)
5. Conclusions
Acknowledgments
References
- Author 1, Yoon, So-Hyun. “A Study on the Improvement for Cost Modelling Techniques in the Construction VE”. MSc Thesis, University of Seoul, Seoul, South Korea 2001; pp. i–iii.
- Author 1, Heo, Won-Young. “The Methodology of Decision Making for VE Components by Cost Index of Building Work”. Doctoral Thesis, Hoseo University, Asan-si, Chungcheongnam-do, South Korea 2022; pp. 3–11.
- Author 1, Lee, Hwa-Seok. “An Improvement of the Quantity Take-off Process for Reducing Errors During Detailed Design Development of Building Projects”. MSc Thesis, Chung-Ang University, Seoul, South Korea 2014, P9; pp. 12–14.
- Author 1, Lee, Do-Hyung. “An Efficient Owner’s Requirements Reflecting Process at the Planning Stage of the Building Project”. Doctoral Thesis, Chung-Ang University, Seoul, South Korea 2006; p. 4.
- Author 1, Jeong, Ho-Geun. “Improvement of the Design Phase VE Selection by the Analysis of the Required Items of Owners, Users and Experts in the Apartment”. MSc Thesis, Dong Eui University, Busan, South Korea 2008; p. 2.
- Author 1, Wei Tong Chen; Author 2, Po-Yi Chang. ; Author 3, Ying-Hua Huang. “Assessing the overall performance of value engineering workshops for construction projects”. International Journal of Project Management 2010, 28, 514–527. [Google Scholar]
- Author 1, Jae, Hyung-Su. “A Study on Method for Effective Function Definition of Construction Project Design Value Engineering”. MSc Thesis, Namseoul University, Cheonan-si, Chuncheongnam-do, South Korea 2010; pp. 45–48.
- Author 1, Jeong, Seong-Eun. “A Process Model for Design Value Engineering(VE) Using the Chimera Idea Creation Concept(CICC)”. MSc Thesis, Namseoul University, Cheonan-si, Chuncheongnam-do, South Korea 2012; pp. 24–25.
- Author 1, Kim, Min-Seung. “Improvement of Design VE Process Using the Quality Model by Construction Project Type”. MSc Thesis, Namseoul University, Cheonan-si, Chuncheongnam-do, South Korea 2010; pp. 39–40.
- Author 1, Qiao,Le. “A Comparative Study on Construction VE System in Korea and China”. MSc Thesis, Kyungpook National University, Daegu, South Korea 2016; pp. 54–56.
- Author 1, Bae,Yu-Jung. “Design Verification Model using Quality Function Deployment(QFD) by Participants in Architectural Projects”. MSc Thesis, Dankook University, Yongin-si, Gyeonggi-do, South Korea 2017; p. 2.
- Author 1,Park,Se-Mee. “A Proposal of Efficiency VE Process Model using Smart Technology”. MSc Thesis, Namseoul University, Cheonan-si, Chuncheongnam-do, South Korea 2021; pp. 28–30.
- Author 1, Park, Bo-Sung. “Design VE Decision Making Model at the Pre-construction Stage of the CM at Risk Project”. Doctoral Thesis, Chungbuk National University, Cheongju, South Korea 2023; pp. 66–68.
- Author 1, Kwon,Byung-Suk. “A Study on Improvement of Subjection Method for Value Engineering in Early Design Stage”. MSc Thesis, Dankook University, Yongin-si, Gyeonggi-do, South Korea 2001; pp. 25–31.
- Author 1, Yun Su-Won; Author 2, Kim Hong-Hyun; Author 3, Min Kyung-Seok. “Improvement for Subject Selection using SWOT Analysis in the Design Value Engineering”. Korean Society of Construction Management Annual Conference, 7 November 2008; pp. 872–876. [Google Scholar]
- Author 1, Rong Zhang; Author 2, Baabak Ashuri; Author 3, Yu Shyr; Author43, Yong Deng. “Forecasting Construction Cost Index based on visibility graph: A network approach". Physica A, 2018, 493, 239–252. [Google Scholar] [CrossRef]
- Author 1, Jung,Ji-Ahn. “VE Object Selection Method of Express Way by Value Index”. MSc Thesis, Pukyong National University, Busan, South Korea 2010; pp. 37–41.
- Author 1, Kim Jae-Hyun. “Advance of Method for An Object Selection in Construction Value Engineering”. MSc Thesis, Pukyong National University, Busan, South Korea 2011; p. V.
- Author 1, Kim Seon-Mi. “A Comparison of Structural Equation Model Estimation Methods According to the Attributes of Likert Scale Data”. MSc Thesis, Keimyung University, Daegu, South Korea 2011, 10; p. 104.

| VE target selection method | Evaluation standard | Evaluation items | Characteristic |
|---|---|---|---|
| High-cost field selection technique |
Cost | Select high-cost items | Construction that is easy to calculate costs |
| Cost to Worth Technique | Comprehensively judge cost and value | VI = Cost÷Worth Select the item with the highest VI value | Construction that is easy to calculate costs or has past performance data When using Worth, use the concept of functional analysis |
| Cost performance evaluation technique | Comprehensively judge cost and performance | Item with the lowest performance ratio/cost ratio value | Construction with insufficient past performance data Performance evaluation criteria include orderer/user requirements, construction period, etc. |
| Complex evaluation technique | Expected improvement effects, available effort, team capabilities, etc. | Evaluation by evaluation item [Scale: Symbol] |
Large scale project Construction VE |
| Building use | Number of samples | Unit construction cost average (KRW/㎡) |
SEM (standard error of the mean) |
Standard Deviation |
Minimum construction cost per unit area (KRW/㎡) |
Maximum construction cost per unit area (KRW/㎡) |
|
|---|---|---|---|---|---|---|---|
| Public building | General | 163 | 3,369,047.5 | 45,369.2 | 579,234.6 | 2,072,265 | 5,158,590 |
| Large | 74 | 3,328,716.6 | 111,514.5 | 959,284.3 | 2,465,224 | 10,584,173 | |
| Library | 21 | 3449470.3 | 115,376.0 | 528,719.1 | 2,267,530 | 4,195,593 | |
| Warehouse | 8 | 1,897,827.3 | 166,336.4 | 470,470.5 | 1,164,246 | 2,836,082 | |
| Dormitory | 14 | 3,400,605.6 | 133,406.2 | 499,160.4 | 2,714,915 | 4,474,552 | |
| Factory | 23 | 2,867,950.1 | 203,884.8 | 977,797.3 | 1,385,877 | 4,839,010 | |
| Welfare facilities | 22 | 3,640,164.6 | 220,683.2 | 1,035,096.0 | 2,735,033 | 7,716,943 | |
| medical facilities | 16 | 3,559,654.4 | 99,429.1 | 397,716.3 | 2,702,300 | 4,251,077 | |
| Training facilities | 29 | 3,908,666.6 | 176,132.3 | 948,501.6 | 2,628,219 | 6,307,060 | |
| Sports facilities | 41 | 4,481,404.3 | 201,608.4 | 1,290,923.3 | 3,029,790 | 10,324,043 | |
| Exhibition facilities | 49 | 3,956,687.2 | 111,544.7 | 780,813.0 | 2,874,435 | 6,653,951 | |
| Facilities for the elderly |
50 | 3,380,304.9 | 93,702.0 | 662,573.3 | 2,499,938 | 5,718,689 | |
| University | 56 | 3,011,569.6 | 51,564.2 | 385,871.3 | 2,449,153 | 4,354,924 | |
| Laboratory | 53 | 3,739,241.5 | 111,069.6 | 808,598.8 | 2,578,894 | 6,471,361 | |
| Subtotal | 619 | 3,427,950.7 | 131,544.3 | 737,482.8 | 2,397,701.3 | 5,991,860 | |
| Factor | Regression equation |
Correlation coefficient |
Adjusted Coefficient of Determination |

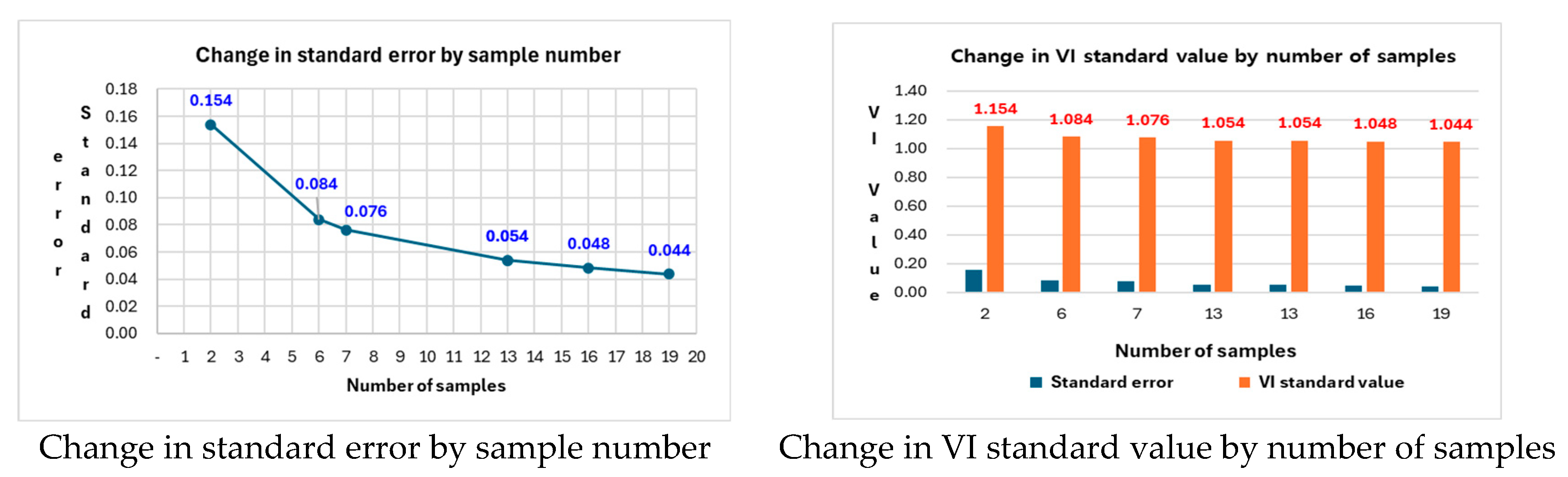

Significance level |
|
|---|---|---|---|---|---|
| Total floor area | Y=3E+0.6X-4E+0.8 | 0.972063 | =0.9449 | 0.9447 | 6.4E-150 |
| Site area | Y=69605X+2E+10 | 0.115279 | =0.0133 | 0.0091 | 7.7E-02 |
| Building area | Y=5E+0.6X+1E+10 | 0.418012 | =0.1747 | 0.1712 | 1.9E-11 |
| Building to Land Ratio | Y=8E+0.7X+2E+10 | 0.057906 | =0.0034 | -0.0009 | 3.7E-01 |
| Floor area ratio | Y=8E+0.7X+2E+10 | 0.204732 | =0.0419 | 0.0378 | 1.5E-03 |
| Number of floors | Y=8E+0.9X-1E+10 | 0.652180 | =0.4253 | 0.4229 | 4.3E-30 |
| Location | Y=2E+0.8X+2E+10 | 0.037360 | =0.0014 | -0.0029 | 5.7E-01 |
| Division | Detailed work type | Average market share | ||
|---|---|---|---|---|
| General government building (163) |
Large government building (74) |
All government building (237) |
||
| Building | Temporary | 5.73% | 5.36% | 5.62% |
| Foundation | 1.79% | 1.30% | 1.64% | |
| Reinforced concrete | 15.36% | 12.96% | 14.61% | |
| Iron frame | 1.47% | 2.32% | 1.73% | |
| Brick | 1.80% | 1.56% | 1.72% | |
| Waterproofing | 2.62% | 2.24% | 2.50% | |
| Stone | 3.95% | 3.03% | 3.66% | |
| Tile | 1.24% | 0.74% | 1.09% | |
| Metal | 4.74% | 4.75% | 4.74% | |
| Platering | 1.68% | 1.32% | 1.57% | |
| Windows & Glass | 4.80% | 4.79% | 4.80% | |
| Wood & Interior finishing | 13.30% | 9.44% | 12.09% | |
| Painting | 1.35% | 1.26% | 1.32% | |
| Dismantling and demolition | 0.56% | 0.71% | 0.61% | |
| Waste disposal | 0.02% | 0.00% | 0.02% | |
| Gravel & Transportation | 0.57% | 0.46% | 0.54% | |
| Work by-product | -0.05% | -0.07% | -0.06% | |
| Quality test fee | 0.08% | 0.09% | 0.08% | |
| Other | 2.16% | 2.30% | 2.21% | |
| Subtotal | 63.16% | 54.57% | 60.48% | |
| Mechanical | Equipment installation | 1.21% | 1.14% | 1.19% |
| Outdoor plumbing | 0.11% | 0.09% | 0.10% | |
| Machine room plumbing | 0.82% | 1.07% | 0.89% | |
| Air conditioning piping | 0.65% | 1.35% | 0.87% | |
| Gas piping | 0.37% | 0.22% | 0.32% | |
| Water supply piping | 1.10% | 0.94% | 1.05% | |
| Sewage piping | 0.98% | 0.97% | 0.98% | |
| Heating piping | 0.17% | 0.12% | 0.15% | |
| Flue installation | 0.09% | 0.15% | 0.11% | |
| Duct installation | 1.24% | 2.47% | 1.62% | |
| Rainwater treatment facility | 0.26% | 0.37% | 0.30% | |
| Sanitary equipment installation | 0.71% | 0.53% | 0.65% | |
| Underfloor heating | 0.04% | 0.06% | 0.05% | |
| Geothermal facility | 0.39% | 0.88% | 0.55% | |
| Soundproofing and dustproofing installation | 0.11% | 0.24% | 0.15% | |
| Other | 0.76% | 1.58% | 1.02% | |
| Subtotal | 9.00% | 12.19% | 10.00% | |
| Electrical | Electricity inlet | 0.63% | 0.51% | 0.60% |
| Main power line facility | 1.63% | 1.42% | 1.56% | |
| Outdoor security lighting | 0.49% | 0.26% | 0.41% | |
| Power facility | 0.79% | 0.81% | 0.79% | |
| Remote meter reading facility | 0.05% | 0.06% | 0.05% | |
| Lighting equipment | 3.01% | 2.99% | 3.01% | |
| Lighting and power control facility | 0.17% | 0.22% | 0.19% | |
| Electric heating equipment | 1.61% | 1.40% | 4.54% | |
| Heating/cooling equipment | 0.42% | 0.38% | 0.41% | |
| Grounding and lightning protection | 0.57% | 0.33% | 0.49% | |
| Cable tray and duct facility | 0.44% | 0.51% | 0.46% | |
| Other | 0.40% | 0.46% | 0.42% | |
| Subtotal | 10.21% | 9.35% | 9.94% | |
| Telecommunications | Outdoor communication equipment | 0.35% | 0.27% | 0.33% |
| Integrated wiring facility | 2.61% | 2.77% | 2.66% | |
| CATV and TV equipment | 0.48% | 0.47% | 0.47% | |
| Broadcasting facilities | 0.69% | 0.66% | 0.68% | |
| A/V equipment | 0.22% | 0.19% | 0.21% | |
| CCTV facility | 0.26% | 0.33% | 0.28% | |
| Access control equipment | 0.25% | 0.49% | 0.32% | |
| Parking control facility | 0.06% | 0.10% | 0.07% | |
| Cable tray and duct installation | 0.47% | 0.50% | 0.48% | |
| Other | 0.17% | 0.30% | 0.21% | |
| Subtotal | 5.57% | 6.08% | 5.73% | |
| Firefighting | Fire extinguishing equipment installation | 0.28% | 0.20% | 0.26% |
| Outdoor fire-fighting piping | 0.04% | 0.03% | 0.04% | |
| Indoor fire-fighting piping | 0.62% | 0.67% | 0.64% | |
| Pump room piping | 0.26% | 0.15% | 0.22% | |
| Sprinkler piping | 0.89% | 2.00% | 1.24% | |
| Fire extinguishing gas piping | 0.12% | 0.22% | 0.15% | |
| Fire extinguishing | 0.17% | 0.21% | 0.18% | |
| Smoke control duct installation | 0.01% | 0.14% | 0.05% | |
| Guide light equipment | 0.54% | 0.51% | 0.53% | |
| Automatic fire detection | 1.57% | 1.52% | 1.56% | |
| Wireless communication auxiliary equipment | 0.03% | 0.16% | 0.07% | |
| Other | 0.38% | 0.20% | 0.33% | |
| Subtotal | 4.91% | 6.02% | 5.26% | |
| Civil | Earth retaining facility | 3.46% | 3.88% | 3.60% |
| Earth construction | 2.27% | 2.72% | 2.41% | |
| Rainwater treatment | 0.90% | 0.43% | 0.75% | |
| Sewage treatment | 0.24% | 0.15% | 0.21% | |
| Water construction | 0.04% | 0.02% | 0.03% | |
| Paving construction | 0.73% | 0.44% | 0.64% | |
| Civil structural | 0.65% | 0.30% | 0.54% | |
| Company-supplied materials | 0.72% | 0.48% | 0.65% | |
| Transportation costs | 0.03% | 0.02% | 0.03% | |
| Other | 0.56% | 0.40% | 0.51% | |
| Subtotal | 9.61% | 8.83% | 9.37% | |
| Landscaping | Planting | 1.65% | 1.68% | 1.66% |
| Pedestrian road paving | 0.76% | 0.44% | 0.66% | |
| Landscaping facilities | 0.53% | 0.70% | 0.58% | |
| Other | 0.09% | 0.14% | 0.11% | |
| Subtotal | 3.03% | 2.95% | 3.00% | |
| Total | 100.00% | 100.00% | 100.00% | |
| Division | Detailed work type | Importance of required functions for each detailed construction type | ||||
|---|---|---|---|---|---|---|
| Very Important function | Important function | Normal function | Basic function | Minimum function | ||
| 1.6 | 1.3 | 1.0 | 0.7 | 0.4 | ||
| Building | Temporary | |||||
| Foundation | ||||||
| Reinforced concrete | ||||||
| Iron frame | ||||||
| Brick | ||||||
| Waterproofing | ||||||
| Stone | ||||||
| Tile | ||||||
| Metal | ||||||
| Plastering | ||||||
| Windows & Glass | ||||||
| Wood & Interior finishing | ||||||
| Painting | ||||||
| Dismantling and demolition | ||||||
| Waste disposal | ||||||
| Gravel & Transportation | ||||||
| Work by-product | ||||||
| Quality test fee | ||||||

| Detailed construction work in the field of public building construction | Cost share WorthC (A) | Customer value WorthV weighting (B) | Final WorthF (A×B) |
|---|---|---|---|
| Temporary | 4.85% | 0.4 | 1.94% |
| Foundation | 7.84% | 1.0 | 7.84% |
| Reinforced concrete | 17.85% | 0.7 | 12.50% |
| Iron frame | 0.62% | 1.0 | 0.62% |
| Brick | 2.18% | 0.7 | 1.53% |
| Waterproofing | 2.06% | 1.6 | 3.30% |
| Stone | 4.79% | 1.3 | 6.23% |
| Tile | 1.04% | 1.3 | 1.35% |
| Metal | 3.20% | 1.3 | 4.16% |
| Plastering | 1.71% | 0.7 | 1.20% |
| Windows & Glass | 4.44% | 1.3 | 5.77% |
| Wood & Interior | 7.67% | 1.6 | 12.27% |
| Painting | 1.02% | 1.3 | 1.33% |
| Waste disposal | 0.04% | 0.7 | 0.03% |
| Gravel & Transportation | 0.70% | 0.7 | 0.49% |
| Other (Architect) | 1.36% | 0.7 | 0.95% |
| Subtotal | 61.37% | 1.0 | 61.51% |

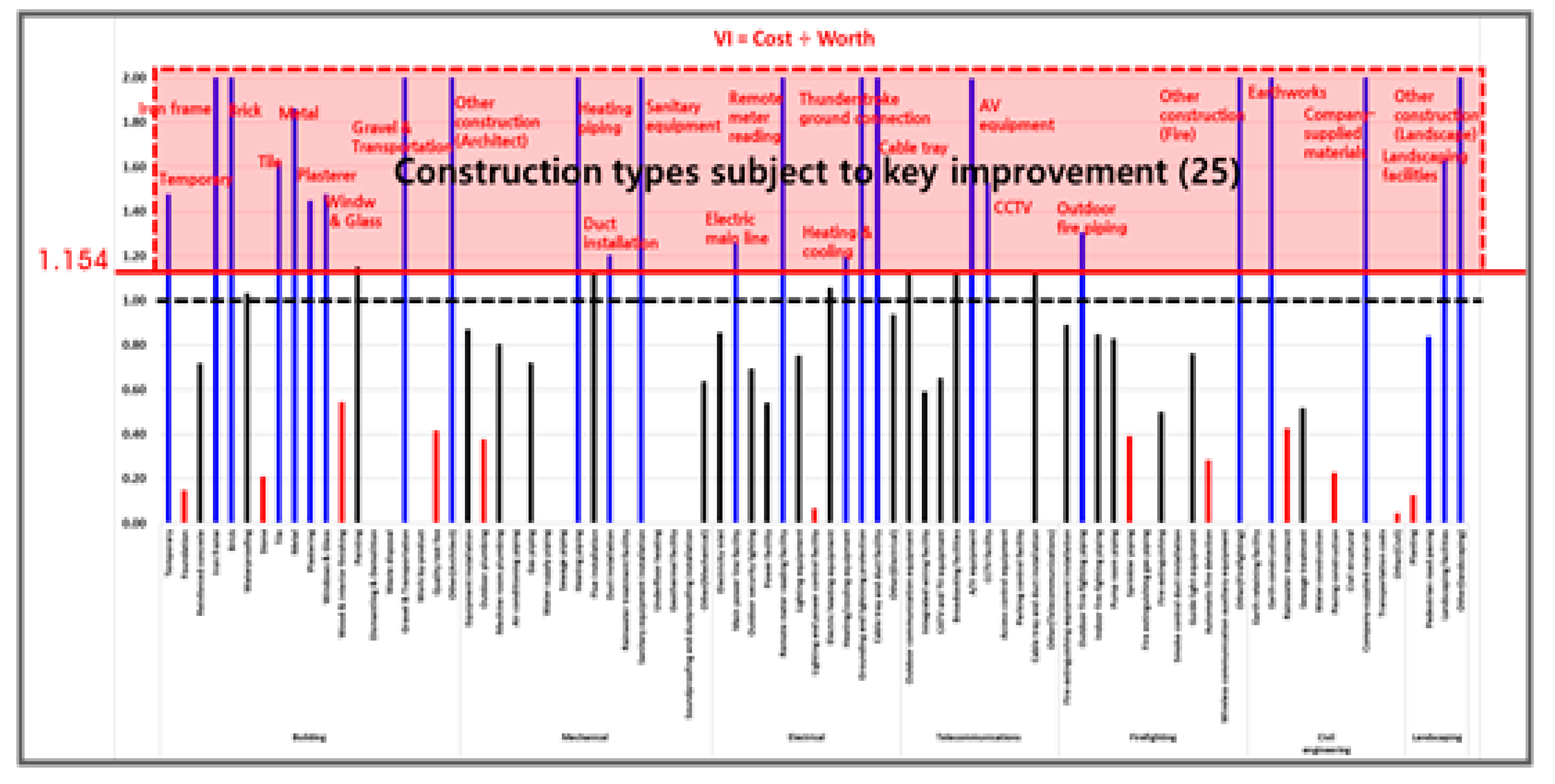

| Detailed construction work in the field of public building construction | Of the project Cost (C) | Final WorthF (D) |
VI (value index) (C÷D) |
|---|---|---|---|
| Temporary | 5.02% | 1.94% | 2.59 |
| Foundation | 5.15% | 7.84% | 0.66 |
| Reinforced concrete | 12.85% | 12.49% | 1.03 |
| Iron frame | 1.41% | 0.62% | 2.27 |
| Brick | 4.95% | 1.53% | 3.24 |
| Waterproofing | 2.76% | 3.30% | 0.84 |
| Stone | 1.01% | 6.23% | 0.16 |
| Tile | 1.68% | 1.35% | 1.24 |
| Metal | 4.96% | 4.16% | 1.19 |
| Plastering | 1.74% | 1.20% | 1.45 |
| Windows & Glass | 6.57% | 5.77% | 1.14 |
| Wood & Interior | 6.67% | 12.27% | 0.54 |
| Painting | 1.17% | 1.33% | 0.88 |
| Waste disposal | 0.08% | 0.03% | 2.67 |
| Gravel & Transportation | 1.16% | 0.49% | 2.37 |
| Other (Architect) | 4.09% | 0.95% | 4.31 |
| Subtotal | 61.27% | 61.50% | 0.996 |
| Progress Project | Total floor area similarity (㎡) | Cumulative number of samples |
Number of floors | SEM (standard error of the mean) |
|---|---|---|---|---|
| Building use : Public building Number of floors: Basement floors(1) Ground floors(4) Total floor area : 6,993㎡ |
99%(6,923~7,063) | 2 | Basement floors(1) Ground floors(4) |
0.15405467 |
| 95%(6,643~7,342) | 6 | 0.08385151 | ||
| 90%(6,293~7,692) | 7 | 0.07630537 | ||
| 85%(5,944~8,042) | 13 | 0.05403102 | ||
| 80%(5,594~8,391) | 13 | 0.05403102 | ||
| 75%(5,244~8,741) | 16 | 0.04819095 | ||
| 70%(4,895~9,090) | 19 | 0.04374134 |
| Progress Project | Daegu Gangbuk Fire Station New Construction |
![]() |
| Location | Guam-dong, Buk-gu, Daegu | |
| Local district | Central commercial area | |
| Building use | Public building | |
| Number of floors | Basement floors(1) Ground floors(4) |
|
| Site area | 8,009.90㎡ | |
| Total floor area | 6.993.04㎡ | |
| Building to Land Ratio | 30.79% | |
| Floor area ratio | 71.52% | |
| Total construction cost | 17,582,741,000KRW |
| Architectural field Detailed work | Cost share WorthC (A) | Customer value WorthV (B) | Total WorthF (A×B) |
|---|---|---|---|
| Temporary | 4.85% | 0.7 | 3.395% |
| Foundation | 7.84% | 1.0 | 7.84% |
| Reinforced concrete | 17.85% | 1.0 | 17.85% |
| Iron frame | 0.62% | 1.0 | 0.62% |
| Brick | 2.18% | 0.7 | 1.526% |
| Waterproofing | 2.06% | 1.3 | 2.678% |
| Stone | 4.79% | 1.0 | 4.79% |
| Tile | 1.04% | 1.0 | 1.04% |
| Metal | 3.20% | 1.0 | 3.2% |
| Plastering | 1.71% | 0.7 | 1.197% |
| Windows & Glass | 4.44% | 1.0 | 4.44% |
| Wood & Interior | 7.67% | 1.6 | 12.272% |
| Painting | 1.02% | 1.0 | 1.02% |
| Waste disposal | 0.04% | 0.4 | 0.016% |
| Gravel & Transportation | 0.70% | 0.4 | 0.28% |
| Other (Architect) | 1.36% | 1.0 | 1.36% |
| Subtotal | 61.37% | 0.93 | 63.524% |
| Division | Detailed | VI value | Number of ideas | Increase/decrease amount(KRW) |
|---|---|---|---|---|
| Building | Temporary | 1.48 | 3 | -33,600,000 |
| Iron frame | 2.28 | 3 | -50,800,000 | |
| Brick | 3.90 | |||
| Tile | 1.61 | |||
| Metal | 1.86 | 3 | -354,200,000 | |
| Plastering | 1.45 | 2 | -52,000,000 | |
| Windows & Glass | 1.48 | 5 | ||
| Gravel & Transportation | 4.13 | 1 | ||
| Other construction | 2.20 | 3 | -217,700,000 | |
| Mechanical | Heating piping | 3.98 | 2 | -42,700,000 |
| Duct installation | 1.21 | 2 | -1,650,000 | |
| Sanitary equipment | 4.23 | 1 | ||
| Electrical | Electric main line | 1.26 | 5 | -93,000,000 |
| Remote meter reading | 3.02 | 2 | -74,700,000 | |
| Heating & cooling | 1.20 | 1 | -1,500,000 | |
| Thunderstroke ground connection | 5.90 | 1 | -1,000,000 | |
| Cable tray | 2.58 | 1 | -12,000,000 | |
| Telecommunications | AV equipment | 2.00 | 4 | -39,000,000 |
| CCTV | 1.53 | |||
| Firefighting | Outdoor fire piping | 1.31 | 2 | -12,600,000 |
| Other construction | 145.62 | 3 | -58,500,000 | |
| Civil | Earthwork | 11.85 | 2 | -233,100,000 |
| Company-supplied materials | 22.05 | 2 | -268,000,000 | |
| Landscaping | Landscaping facilities | 1.64 | 1 | -34,400,000 |
| Other construction | 2.65 | 2 | -600,000 | |
| Subtotal | 11.85 | 51 | -1,581,050,000 | |
| VE implementation steps | Target Project | Sample target | Number of target selected construction types derived from this study | Number of construction types for deriving target project ideas | Match rate |
|---|---|---|---|---|---|
| Design stage | Gangbuk Fire Station |
Jeongseon Police Station | 25 | 22 | 88% |
| Changwon Marine Police Station |
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content. |
© 2024 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (http://creativecommons.org/licenses/by/4.0/).
