Submitted:
19 March 2024
Posted:
22 March 2024
You are already at the latest version
Abstract
Keywords:
1. Introduction
2. Literature Review
3. Methods
3.1. Delphi Survey
3.2. Focus Group
3.3. ISM Model
3.4. Fuzzi MICMAC Analysis
3.5. Development of Mitigation Measures
4. Results
4.1. Critical Barriers to BIMI
4.1.1. Identification of the Barriers to BIMI
4.1.2. Determination of the Critical Barriers to BIM

4.2. ISM Model
4.2.1. Contextual Relationships
4.2.2. Transformation of the SSIM into the Initial Reachability Matrix
4.2.3. Transitivity Check and Conversion of the IRM into the Final Reachability Matrix
4.2.4. Level Partitioning of the Barriers
4.2.5. Development of the ISM Model and Consistency Check

4.3. Fuzzy MICMAC Analysis
4.3.1. Preparing Binary Direct Relationship Matrix
4.3.2. Collecting the Strength of Interaction between Barriers
4.3.3. Fuzzy Direct Relationship Matrix Stabilization
4.3.4. Classification of the Barriers to BIMI into Four Clusters
5. Discussion and Mitigation Measures
5.1. Discussion
5.2. Mitigation Measures
6. Conclusions
Supplementary Materials
Author Contributions
Funding
Institutional Review Board Statement
Informed Consent Statement
Data Availability Statement
Acknowledgments
Conflicts of Interest
References
- EU BIM Task Group Handbook for the Introduction of Building Information Modelling by the European Public Sector -Strategic Action for Construction Sector Performance: Driving Value, Innovation and Growth; 2017.
- IMPIC Relatório Do Setor Da Construção Em 2021 - 1o Semestre; Lisboa, Portugal, 2021.
- Euroestat Construction Sector - Gross Value Added of the Construction Sector in the EU.
- Barbosa, F.; Woetzel, J.; Mischke, J.; João, M.; Sridhar, M.; Parsons, M.; Bertram, N.; Brown, S. Reinventing Construction: A Route to Higher Productivity; McKinsey, 2017.
- Li, J.; Li, N.; Peng, J.; Cui, H.; Wu, Z. A Review of Currently Applied Building Information Modeling Tools of Constructions in China. J. Clean. Prod. 2018, 201, 358–368. [Google Scholar] [CrossRef]
- Seaden, G.; Manseau, A. Public Policy and Construction Innovation. Build. Res. Inf. 2001, 29, 182–196. [Google Scholar] [CrossRef]
- Sun, C.; Xu, H.; Jiang, S. Understanding the Risk Factors of BIM Technology Implementation in the Construction Industry: An Interpretive Structural Modeling (ISM) Approach. Eng. Constr. Archit. Manag. 2020, 27, 3289–3308. [Google Scholar] [CrossRef]
- Zhou, Y.; Yang, Y.; Yang, J.B. Barriers to BIM Implementation Strategies in China. Eng. Constr. Archit. Manag. 2019, 26, 554–574. [Google Scholar] [CrossRef]
- Olawumi, T.O.; Chan, D.W.M.; Wong, J.K.W.; Chan, A.P.C. Barriers to the Integration of BIM and Sustainability Practices in Construction Projects: A Delphi Survey of International Experts. J. Build. Eng. 2018, 20, 60–71. [Google Scholar] [CrossRef]
- Sun, C.; Jiang, S.; Skibniewski, M.J.; Man, Q.; Shen, L. A Literature Review of the Factors Limiting the Application of BIM in the Construction Industry. Technol. Econ. Dev. Econ. 2017, 23, 764–779. [Google Scholar] [CrossRef]
- Jones, S.A.; Young Jr., N.W.; Bernstein, H.M. Building Information Modeling (BIM): Transforming Design and Construction to Achieve Greater Industry Productivity; McGraw-Hill Construction, 2008. ISBN 978-1-934926-25-3.
- Onososen, A.; Musonda, I. Barriers to BIM-Based Life Cycle Sustainability Assessment for Buildings: An Interpretive Structural Modelling Approach. Buildings 2022, 12. [Google Scholar] [CrossRef]
- Charef, R.; Emmitt, S.; Alaka, H.; Fouchal, F. Building Information Modelling Adoption in the European Union: An Overview. J. Build. Eng. 2019, 25, 13. [Google Scholar] [CrossRef]
- Pérez-García, A.; Martín-Dorta, N.; Aranda, J.Á. Bim Requirements in the Spanish Public Tender—Analysis of Adoption in Construction Contracts. Buildings 2021, 11. [Google Scholar] [CrossRef]
- Olanrewaju, O.I.; Chileshe, N.; Babarinde, S.A.; Sandanayake, M. Investigating the Barriers to Building Information Modeling (BIM) Implementation within the Nigerian Construction Industry. Eng. Constr. Archit. Manag. 2020, 27, 2931–2958. [Google Scholar] [CrossRef]
- Kassem, M.; Succar, B. Macro BIM Adoption: Comparative Market Analysis. Autom. Constr. 2017, 81, 286–299. [Google Scholar] [CrossRef]
- Gu, N.; London, K. Understanding and Facilitating BIM Adoption in the AEC Industry. Autom. Constr. 2010, 19, 988–999. [Google Scholar] [CrossRef]
- Rogers, J.; Chong, H.-Y.; Preece, C. Adoption of Building Information Modelling Technology (BIM). Eng. Constr. Archit. Manag. 2015, 22, 91–107. [Google Scholar] [CrossRef]
- Manzoor, B.; Othman, I.; Gardezi, S.S.S.; Altan, H.; Abdalla, S.B. Bim-Based Research Framework for Sustainable Building Projects: A Strategy for Mitigating Bim Implementation Barriers. Appl. Sci. 2021, 11. [Google Scholar] [CrossRef]
- Matarneh, R.; Hamed, S. Barriers to the Adoption of Building Information Modeling in the Jordanian Building Industry. Open J. Civ. Eng. 2017, 07, 325–335. [Google Scholar] [CrossRef]
- Gamil, Y.; Rahman, I.A.R. Awareness and Challenges of Building Information Modelling (BIM) Implementation in the Yemen Construction Industry. J. Eng. Des. Technol. 2019, 17, 1077–1084. [Google Scholar] [CrossRef]
- Hosseini, M.R.; Azari, E.; Tivendale, L.; Chileshe, N. Barriers to Adoption of Building Information Modeling (BIM) in Iran: Preliminary Results. In Proceedings of the International Conference on Engineering Project And Production Management - EPPM, 2015; 2015; pp. 384–394. [Google Scholar]
- Hosseini, M.R.; Banihashemi, S.; Chileshe, N.; Namzadi, M.O.; Udaeja, C.; Rameezdeen, R.; McCuen, T. BIM Adoption within Australian Small and Medium-Sized Enterprises (SMEs): An Innovation Diffusion Model. Constr. Econ. Build. 2016, 16, 71–86. [Google Scholar] [CrossRef]
- Ma, X.; Darko, A.; Chan, A.P.C.; Wang, R.; Zhang, B. An Empirical Analysis of Barriers to Building Information Modelling (BIM) Implementation in Construction Projects: Evidence from the Chinese Context. Int. J. Constr. Manag. 2020, 1–9. [Google Scholar] [CrossRef]
- Ma, G.; Jia, J.; Ding, J.; Shang, S.; Jiang, S. Interpretive Structural Model Based Factor Analysis of BIM Adoption in Chinese Construction Organizations. Sustain. 2019, 11, 1982. [Google Scholar] [CrossRef]
- Saka, A.B.; Chan, D.M. Profound Barriers to Building Information Modelling (BIM) Adoption in Construction Small and Medium-Sized Enterprises (SMEs): An Interpretive Structural Modelling Approach. Constr. Innov. 2020, 20, 261–284. [Google Scholar] [CrossRef]
- Farooq, U.; Ur Rehman, S.K.; Javed, M.F.; Jameel, M.; Aslam, F.; Alyousef, R. Investigating BIM Implementation Barriers and Issues in Pakistan Using ISM Approach. Appl. Sci. 2020, 10, 1–21. [Google Scholar] [CrossRef]
- Kassem, M.; Brogden, T.; Dawood, N. BIM and 4D Planning: A Holistic Study of the Barriers and Drivers to Widespread Adoption. J. Constr. Eng. Proj. Manag. 2012, 2, 1–10. [Google Scholar] [CrossRef]
- Chen, G.X.; Shan, M.; Chan, A.P.C.; Liu, X.; Zhao, Y.Q. Investigating the Causes of Delay in Grain Bin Construction Projects: The Case of China. Int. J. Constr. Manag. 2019, 19, 1–14. [Google Scholar] [CrossRef]
- Saka, A.B.; Chan, D.M.; Siu, F.M.F. Drivers of Sustainable Adoption of Building Information Modelling (BIM) in the Nigerian Construction Small and Medium-Sized Enterprises (SMEs). Sustain. 2020, 12. [Google Scholar] [CrossRef]
- Papadonikolaki, E. Loosely Coupled Systems of Innovation: Aligning BIM Adoption with Implementation in Dutch Construction. J. Manag. Eng. 2018, 34, 05018009. [Google Scholar] [CrossRef]
- Tan, T.; Chen, K.; Xue, F.; Lu, W. Barriers to Building Information Modeling (BIM) Implementation in China’s Prefabricated Construction: An Interpretive Structural Modeling (ISM) Approach. J. Clean. Prod. 2019, 219, 949–959. [Google Scholar] [CrossRef]
- Ambekar, S.; Roy, D.; Hiray, A.; Prakash, A.; Patyal, V.S. Barriers to Adoption of Reverse Logistics: A Case of Construction, Real Estate, Infrastructure and Project (CRIP) Sectors. Eng. Constr. Archit. Manag. 2021. [Google Scholar] [CrossRef]
- Needham, R.D.; de Loë, R.C. The Policy Delphi: Purpose, Structure, and Application. Can. Geogr. / Le Géographe Can. 1990, 34, 133–142. [Google Scholar] [CrossRef]
- Morgan, D.L. Focus Groups. Annu. Rev. Sociol. 1996, 22, 129–152. [Google Scholar] [CrossRef]
- Kitzinger, J. Qualitative Research: Introducing Focus Groups. BMJ 1995, 311, 299. [Google Scholar] [CrossRef]
- Warfield, J.N. Developing Subsystem Matrices in Structural Modeling. IEEE Trans. Syst. Man Cybern. 1974, SMC-4, 74–80. [Google Scholar] [CrossRef]
- Sushil Interpreting the Interpretive Structural Model. Glob. J. Flex. Syst. Manag. 2012, 13, 87–106. [CrossRef]
- Pimentel, M.; Arantes, A.; Cruz, C.O. Barriers to the Adoption of Reverse Logistics in the Construction Industry: A Combined ISM and MICMAC Approach. Sustain. 2022, 14, 15786. [Google Scholar] [CrossRef]
- Gorane, S.J.; Kant, R. Modelling the SCM Implementation Barriers An Integrated ISM-Fuzzy MICMAC Approach. J. Model. Manag. 2015, 10, 158–178. [Google Scholar] [CrossRef]
- Patel, M.N.; Pujara, A.A.; Kant, R.; Malviya, R.K. Assessment of Circular Economy Enablers: Hybrid ISM and Fuzzy MICMAC Approach. J. Clean. Prod. 2021, 317, 128387. [Google Scholar] [CrossRef]
- Arantes, A.; Ferreira, L.M.D.F. Development of Delay Mitigation Measures in Construction Projects: A Combined Interpretative Structural Modeling and MICMAC Analysis Approach. Prod. Plan. Control 2023, 1–16. [Google Scholar] [CrossRef]
- Piroozfar, P.; Farr, E.R.P.; Zadeh, A.H.M.; Timoteo Inacio, S.; Kilgallon, S.; Jin, R. Facilitating Building Information Modelling (BIM) Using Integrated Project Delivery (IPD): A UK Perspective. J. Build. Eng. 2019, 26, 100907. [Google Scholar] [CrossRef]
- Siebelink, S.; Voordijk, H.; Endedijk, M.; Adriaanse, A. Understanding Barriers to BIM Implementation: Their Impact across Organizational Levels in Relation to BIM Maturity. Front. Eng. Manag. 2021, 8, 236–257. [Google Scholar] [CrossRef]
- Bosch-Sijtsema, P.; Isaksson, A.; Lennartsson, M.; Linderoth, H.C.J. Barriers and Facilitators for BIM Use among Swedish Medium-Sized Contractors - “We Wait until Someone Tells Us to Use It. ” Vis. Eng. 2017, 5. [Google Scholar] [CrossRef]
- Ku, K.; Taiebat, M. BIM Experiences and Expectations: The Constructors’ Perspective. Int. J. Constr. Educ. Res. 2011, 7, 175–197. [Google Scholar] [CrossRef]
- Kivits, R.A.; Furneaux, C. BIM: Enabling Sustainability and Asset Management through Knowledge Management. Sci. World J. 2013, 2013, 14. [Google Scholar] [CrossRef]
- Ayinla, K.O.; Adamu, Z. Bridging the Digital Divide Gap in BIM Technology Adoption. Eng. Constr. Archit. Manag. 2018, 25, 1398–1416. [Google Scholar] [CrossRef]
- Chan, C.W. Barriers of Implementing BIM in Construction Industry from the Designers’ Perspective: A Hong Kong Experience. J. Syst. Manag. Sci. 2014, 4, 24–40. [Google Scholar]
- Chan, D.W.M.; Olawumi, T.O.; Ho, A.M.L. Perceived Benefits of and Barriers to Building Information Modelling (BIM) Implementation in Construction: The Case of Hong Kong. J. Build. Eng. 2019, 25, 100764. [Google Scholar] [CrossRef]
- Olanrewaju, O.I.; Kineber, A.F.; Chileshe, N.; Edwards, D.J. Modelling the Relationship between Building Information Modelling (BIM) Implementation Barriers, Usage and Awareness on Building Project Lifecycle. Build. Environ. 2022, 207, 108556. [Google Scholar] [CrossRef]
- Hosseini, M.R.; Rameezdeen, R.; Chileshe, N.; Lehmann, S. Reverse Logistics in the Construction Industry. Waste Manag. Res. 2015, 33, 499–514. [Google Scholar] [CrossRef]
- Aibinu, A.A.; Jagboro, G.O. The Effects of Construction Delays on Project Delivery in Nigerian Construction Industry. Int. J. Proj. Manag. 2002, 20, 593–599. [Google Scholar] [CrossRef]
- Aibinu, A.A.; Venkatesh, S. Status of BIM Adoption and the BIM Experience of Cost Consultants in Australia. J. Prof. Issues Eng. Educ. Pract. 2014, 140, 1–11. [Google Scholar] [CrossRef]
- Sun, Y.; Chen, L.; Sun, H.; Taghizadeh-Hesary, F. Low-Carbon Financial Risk Factor Correlation in the Belt and Road PPP Project. Financ. Res. Lett. 2020, 35, 101491. [Google Scholar] [CrossRef]
- Antón, L.Á.; Díaz, J. Integration of Life Cycle Assessment in a BIM Environment. Procedia Eng. 2014, 85, 26–32. [Google Scholar] [CrossRef]
- Dossick, C.S.; Neff, G. Organizational Divisions in BIM-Enabled Commercial Construction. J. Constr. Eng. Manag. 2010, 136, 459–467. [Google Scholar] [CrossRef]
- Ribeiro, A.M.; Arantes, A.; Cruz, C.O. Barriers to the Adoption of Modular Construction in Portugal: An Interpretive Structural Modelling Approach. Buildings 2022, 12, 1509. [Google Scholar] [CrossRef]
- Kandasamy, V.; Smarandache, F.; Ilanthenral, K. Elementary Fuzzy Matrix Theory and Models for Social Scientists; Multimedia Larga: Los Angeles, 2007; ISBN 9781599730059. [Google Scholar]
- Arantes, A.; Ferreira, L.M.D.F. A Methodology for the Development of Delay Mitigation Measures in Construction Projects. Prod. Plan. Control 2021, 32, 228–241. [Google Scholar] [CrossRef]
- Hosseini, M.R.; Azari, E.; Tivendale, L.; Banihashemi, S.; Chileshe, N. Building Information Modeling (BIM) in Iran: An Exploratory Study. J. Eng. Proj. Prod. Manag. 2016, 6, 78–89. [Google Scholar] [CrossRef]
- Panteli, C.; Kylili, A.; Fokaides, P.A. Building Information Modelling Applications in Smart Buildings: From Design to Commissioning and beyond A Critical Review. J. Clean. Prod. 2020, 265, 121766. [Google Scholar] [CrossRef]
- Hong, Y.; Hammad, A.W.A.; Sepasgozar, S.; Akbarnezhad, A. BIM Adoption Model for Small and Medium Construction Organisations in Australia. Eng. Constr. Archit. Manag. 2019, 26, 154–183. [Google Scholar] [CrossRef]


| No | Barrier | References |
|---|---|---|
| 1 | Lacking functionalities of BIM tools | [7,8,10,25,28,43,44] |
| 2 | Complexity of BIM tools | [9,10,19,21,28,45,46] |
| 3 | BIM-related project risks and potential engineering and information defects | [9,21,26,47] |
| 4 | Immaturity of BIM technology | [24,45] |
| 5 | Interoperability difficulties of the software | [7,9,10,19,20,21,22,23,25,26,27,28,45,46,47,48,49,50,51] |
| 6 | Software acquisition cost | [7,8,9,10,18,19,20,21,23,25,26,27,28,29,45,46,47,48,49,51,52] |
| 7 | IT investment necessary for the transition to BIM | [7,9,10,19,20,21,22,25,26,27,45,47,49,50,51] |
| 8 | Time and capital investment in training | [9,10,20,21,23,24,25,45,47,51,53,54] |
| 9 | Change in work method required | [7,8,10,18,19,20,21,22,24,44] |
| 10 | Lack of BIM standards and implementation strategies | [8,9,10,18,19,20,21,22,23,24,25,26,50,51] |
| 11 | Lack of support and knowledge from top management | [7,9,10,20,21,24,25,26,27,44,45,48] |
| 12 | Need for corporate restructuring | [8,9,10,44,49] |
| 13 | Lack of internal communication protocols | [8,9,10,44,49] |
| 14 | Current methods provide satisfactory results | [9,22,24,26,27] |
| 15 | Weak cooperation in BIM adoption from other stakeholders | [9,19,21,24,25,43,44,45,49,50,51] |
| 16 | Lack of IT structure in the firm | [10,24,49] |
| 17 | Lack of experience within the firm for BIM implementation | [7,8,9,18,19,21,24,27,44,45,47,48,49,51] |
| 18 | Weak cooperation from other industry partners | [10,44,55] |
| 19 | Resistance to change | [7,8,10,19,20,23,26,27,44,45,47,48,50,51,54] |
| 20 | Lack of available BIM training | [19,20,21,22,24,27,43,49,50] |
| 21 | Scarcity of BIM-capable professionals | [7,9,20,22,23,24,27,50,51] |
| 22 | Lack of client demand | [8,9,19,20,21,23,24,26,44,45,48,49,51] |

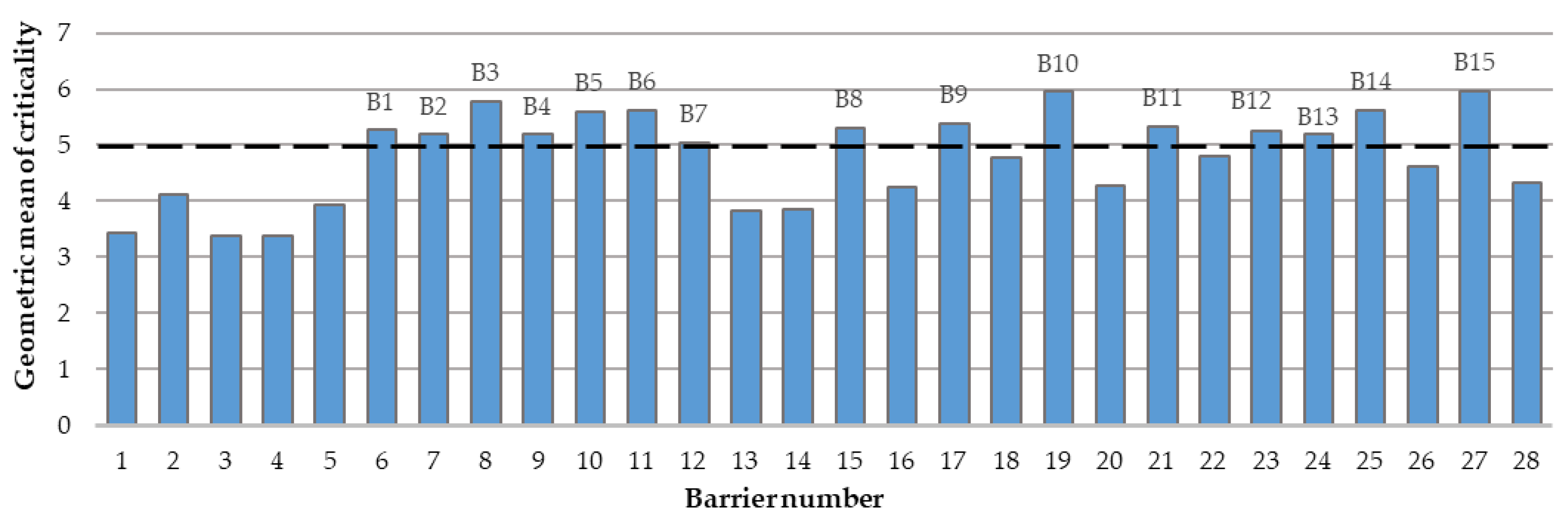

| 23 | Ignorance of BIM capabilities/benefits | [10,19,20,21,23,25,26,48,54] |
| 24 | Lack of evaluation and feedback for successful BIM implementation | [7,8,9,19,22,24,25,29,45,50,51] |
| 25 | Fragmented nature of the construction industry | [9,10,43,44,47,56] |
| 26 | BIM data ownership and rights | [7,8,9,10,19,47,48,49,51] |
| 27 | Lack of government regulation | [8,9,18,19,21,23,24,25,26,27,43,44,47,48,49,51] |
| 28 | Concerns related to the safety and insurance framework of BIM | [7,8,10,19,43,47,49,50] |
| Code | Barrier – description |
|---|---|
| B1 | Software acquisition cost – Decision-makers are often unfamiliar with the possible benefits of BIMI [15], which, when combined with the high cost of software procurement, can result in a perceived negative return on investment (ROI), aggravating the resistance to BIMI [9]. |
| B2 | IT investment necessary for the transition to BIM – Since the BIM process requires significant computing power, most businesses will need to upgrade their current hardware, network, and any other infrastructure component that may be inadequate [9]. |
| B3 | Time and capital investment in training – For successful BIMIs, companies must provide their employees with adequate training, as BIM tools, workflows, and protocols differ from traditional practices. According to Young et al. [11], receiving adequate training in the early stages of BIMI is the greatest challenge to successful BIM. |
| B4 | Change in working methods required – BIM work procedures do not align with traditional work practices. As Sun et al. [7] confirmed, with BIM, there is a need for change in work processes, with the authors adding that the lack of a defined BIMI procedure makes it a management risk. |
| B5 | Lack of BIM standards and implementation strategies – The lack of documentation regarding BIMI strategies significantly deters companies wishing to transition to BIM [19,50]. These standards should cover all the main aspects of BIM, such as data exchange, best practices, necessary workflows, operation and maintenance requirements, and more [8]. |
| B6 | Lack of support and knowledge from top management – The top management is accountable for strategic decisions that affect the company’s future success. They are experienced professionals, are deeply familiar with traditional methods and generally have a risk-averse attitude toward BIM. Their perception of BIM as a disruptive and fad technology might harm the BIMI[48]. |
| B7 | Need for corporate restructuring – As understood by Dossick and Neff [57], projects become heavily reliant on project managers when BIM is implemented without a proper organizational structure that potentiates collaboration. Chan et al. [50] concluded that companies implementing BIM must reassess their current structure and strategy. |
| B8 | Weak cooperation in BIM adoption from other entities involved – AEC projects require the intervention and collaboration of several entities with vested interests in the correct project development. Due to the multidisciplinary nature, all these entities must interact and cooperate most efficiently. This is one of the main strengths of BIM, as it allows for better collaboration and communication. However, to achieve BIM’s full potential, all the parties involved must adopt it and cooperate [8]. |
| B9 | Lack of experience within the company for BIMI – As Kassem et al. [28] stated, technology can only be successfully implemented if the workforce is adequately trained and experienced. When there is insufficient team knowledge and experience at the project level to ensure a seamless transition to BIM, extra costs and time spent on corrections and adjustments result [7]. |
| B10 | Resistance to change – It can be defined as an attitude or conduct that undermines the objective of change, which can cause the procedure to fail. However, the development of new technologies and new and improved methods is a competitive advantage for those who adopt them. Chan et al. [50] considered cultural resistance to change a significant barrier. |
| B11 | Scarcity of BIM professionals – Rogers et al. [18] found that the lack of BIM skills in newly graduated engineers resulted from BIM-deficient university curricula. This issue was also recognized by university representatives among the experts in the present study. |
| B12 | Ignorance of BIM capabilities/benefits – A lack of understanding of the possible benefits of BIMI undermines its potential for success, as companies and their employees don’t see the need for change and what advantages it may bring them [20]. |
| B13 | Lack of evaluation and feedback on successful BIM implementations – BIM is still fairly recent compared to traditional construction methods, resulting in a lack of assessment and feedback regarding its implementation [24]. This is worsened by the fact that the construction industry has a notoriously low investment rate in R&D, which is also true in the case of BIM. |
| B14 | Fragmented nature of the construction industry – A fragmented industry is one where knowledge gained by a team or company during a specific project is not retained and shared with other teams or companies to be used in future projects, as in the construction industry. [9]. For effective BIMI, proper collaboration is essential, as it is one of the cornerstones of the BIM process [7]. |

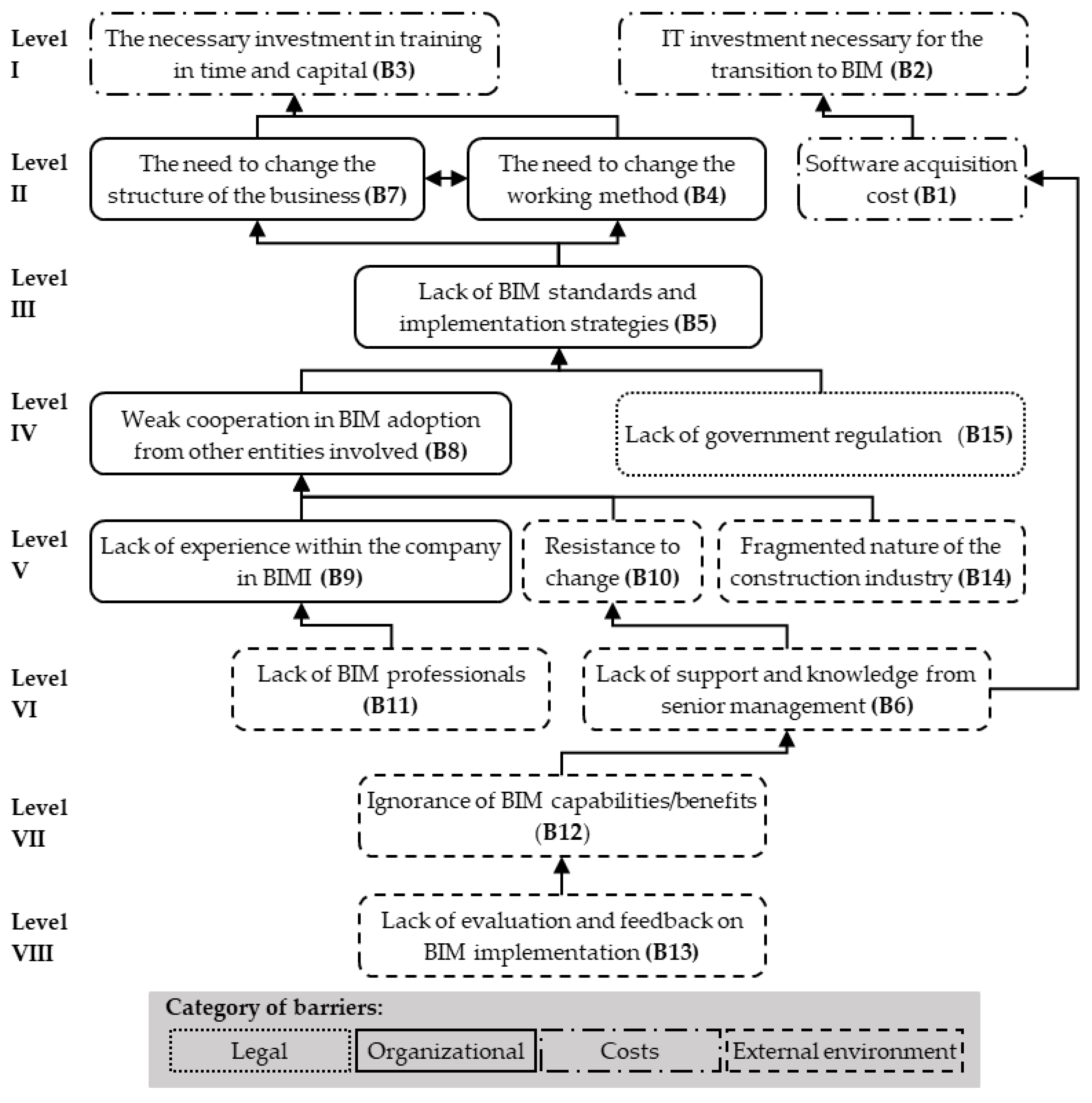

| B15 | Lack of government regulation – The immaturity of the contractual and regulatory legislation regarding BIM is a significant obstacle to its implementation [7]. The lack of mandatory BIM policies and government stimulus through incentives, subsidies, or tax incentives means that companies are unwilling to implement BIM [48]. |
| B(i/j) | 1 | 2 | 3 | 4 | 5 | 6 | 7 | 8 | 9 | 10 | 11 | 12 | 13 | 14 | 15 |
|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|
| 1 | V | O | O | O | A | O | O | O | O | O | O | O | O | O | |
| 2 | O | O | O | A | O | A | O | O | O | A | O | O | O | ||
| 3 | A | A | A | O | O | A | O | A | O | O | O | O | |||
| 4 | A | A | X | O | A | A | O | O | O | A | O | ||||
| 5 | O | V | A | O | O | A | O | A | A | A | |||||
| 6 | V | O | O | V | O | A | A | O | O | ||||||
| 7 | A | A | A | O | O | A | A | O | |||||||
| 8 | A | A | A | O | O | A | O | ||||||||
| 9 | O | A | O | O | O | O | |||||||||
| 10 | O | A | A | O | O | ||||||||||
| 11 | O | O | O | O | |||||||||||
| 12 | A | O | O | ||||||||||||
| 13 | O | O | |||||||||||||
| 14 | O | ||||||||||||||
| 15 | |||||||||||||||
| Note: B(i/j) – Barrier in line i, or column j. | |||||||||||||||
| B(i/j) | 1 | 2 | 3 | 4 | 5 | 6 | 7 | 8 | 9 | 10 | 11 | 12 | 13 | 14 | 15 |
|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|
| 1 | 1 | 1 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 |
| 2 | 0 | 1 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 |
| 3 | 0 | 0 | 1 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 |
| 4 | 0 | 0 | 1 | 1 | 0 | 0 | 1 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 |
| 5 | 0 | 0 | 1 | 1 | 1 | 0 | 1 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 |
| 6 | 1 | 1 | 1 | 1 | 1* | 1 | 1 | 1* | 0 | 1 | 0 | 0 | 0 | 0 | 0 |
| 7 | 0 | 0 | 1* | 1 | 0 | 0 | 1 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 |
| 8 | 0 | 1 | 1* | 1* | 1 | 0 | 1 | 1 | 0 | 0 | 0 | 0 | 0 | 0 | 0 |
| 9 | 0 | 1* | 1 | 1 | 1* | 0 | 1 | 1 | 1 | 0 | 0 | 0 | 0 | 0 | 0 |
| 10 | 0 | 1* | 1* | 1 | 1* | 0 | 1 | 1 | 0 | 1 | 0 | 0 | 0 | 0 | 0 |
| 11 | 0 | 1* | 1 | 1* | 1 | 0 | 1* | 1 | 1 | 0 | 1 | 0 | 0 | 0 | 0 |
| 12 | 1* | 1 | 1* | 1* | 1* | 1 | 1* | 1* | 0 | 1 | 0 | 1 | 0 | 0 | 0 |
| 13 | 1* | 1* | 1* | 1* | 1 | 1 | 1 | 1* | 0 | 1 | 0 | 1 | 1 | 0 | 0 |
| 14 | 0 | 1* | 1* | 1 | 1 | 0 | 1 | 1 | 0 | 0 | 0 | 0 | 0 | 1 | 0 |
| 15 | 0 | 0 | 1* | 1* | 1 | 0 | 1* | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 1 |
| Notes: B(i/j) – Barrier in line i, or column j; 1* is a transitive linkage. | |||||||||||||||
| B(i/j) | 1 | 2 | 3 | 4 | 5 | 6 | 7 | 8 | 9 | 10 | 11 | 12 | 13 | 14 | 15 |
|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|
| 1 | 0 | 0.5 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 |
| 2 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 |
| 3 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 |
| 4 | 0 | 0 | 0.5 | 0 | 0 | 0 | 0.7 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 |
| 5 | 0 | 0 | 0.5 | 0.5 | 0 | 0 | 0.5 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 |
| 6 | 0.3 | 0.5 | 1 | 0.7 | 0 | 0 | 0.3 | 0 | 0 | 0.3 | 0 | 0 | 0 | 0 | 0 |
| 7 | 0 | 0 | 0 | 0.7 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 |
| 8 | 0 | 0.7 | 0 | 0 | 1 | 0 | 0.7 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 |

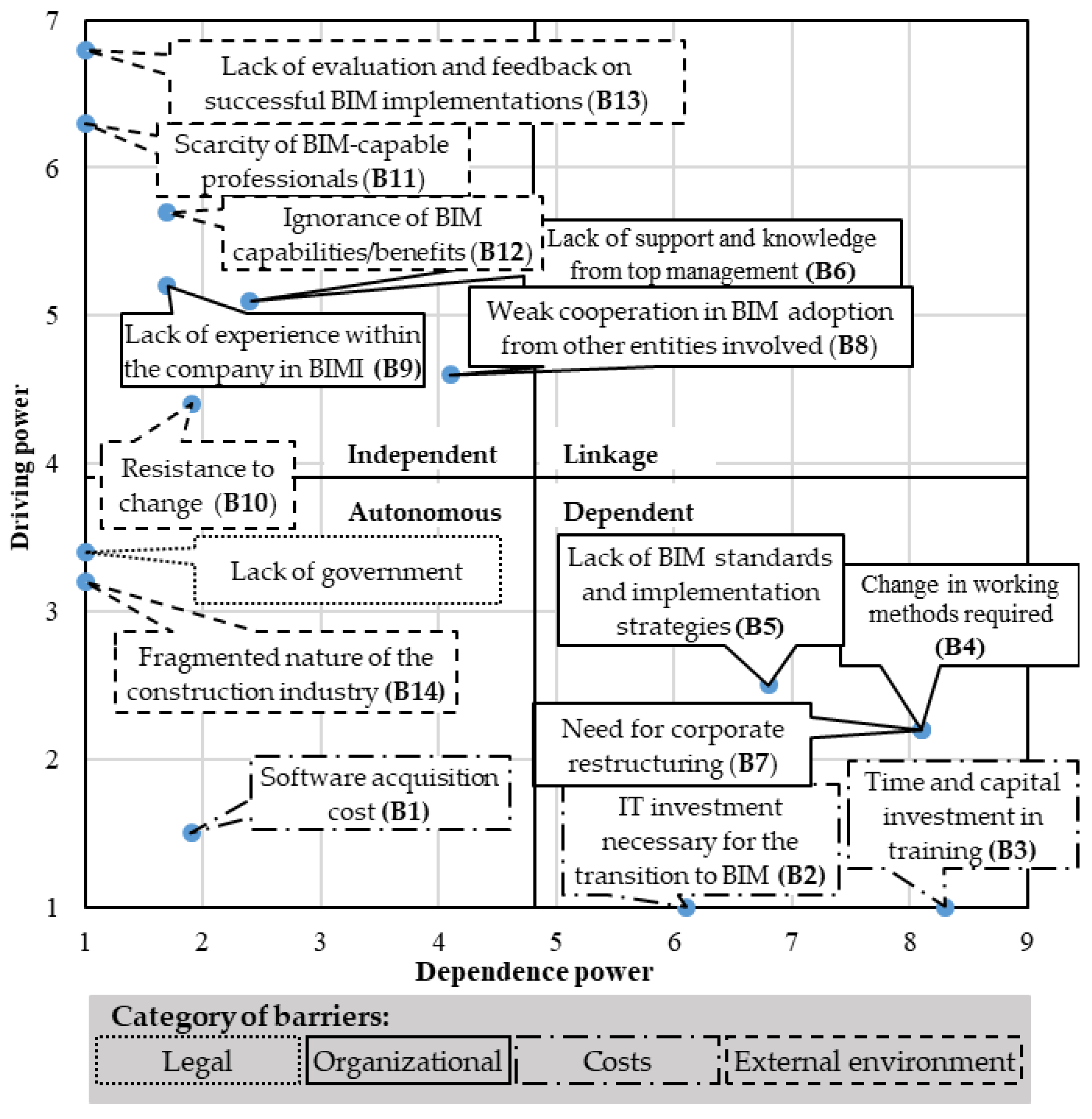

| 9 | 0 | 0 | 0.7 | 0.3 | 0 | 0 | 0.1 | 0.7 | 0 | 0 | 0 | 0 | 0 | 0 | 0 |
| 10 | 0 | 0 | 0 | 0.5 | 0 | 0 | 0.7 | 0.5 | 0 | 0 | 0 | 0 | 0 | 0 | 0 |
| 11 | 0 | 0 | 0.7 | 0 | 0.3 | 0 | 0 | 0.9 | 0.7 | 0 | 0 | 0 | 0 | 0 | 0 |
| 12 | 0 | 0.7 | 0 | 0 | 0 | 0.7 | 0 | 0 | 0 | 0.3 | 0 | 0 | 0 | 0 | 0 |
| 13 | 0 | 0 | 0 | 0 | 0.7 | 0.3 | 0.1 | 0 | 0 | 0.1 | 0 | 0.7 | 0 | 0 | 0 |
| 14 | 0 | 0 | 0 | 0.3 | 0.5 | 0 | 0.5 | 0.1 | 0 | 0 | 0 | 0 | 0 | 0 | 0 |
| 15 | 0 | 0 | 0 | 0 | 0.9 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 |
| Note: B(i/j) – Barrier in line i, or column j. | |||||||||||||||
| B(i/j) | 1 | 2 | 3 | 4 | 5 | 6 | 7 | 8 | 9 | 10 | 11 | 12 | 13 | 14 | 15 | DVP |
|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|
| 1 | 1.0 | 0.5 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 1.5 |
| 2 | 0 | 1.0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 1.0 |
| 3 | 0 | 0 | 1.0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 1.0 |
| 4 | 0 | 0 | 0.5 | 1.0 | 0 | 0 | 0.7 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 2.2 |
| 5 | 0 | 0 | 0.5 | 0.5 | 1.0 | 0 | 0.5 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 2.5 |
| 6 | 0.3 | 0.5 | 1.0 | 0.7 | 0.3 | 1.0 | 0.7 | 0.3 | 0 | 0.3 | 0 | 0 | 0 | 0 | 0 | 5.1 |
| 7 | 0 | 0 | 0.5 | 0.7 | 0 | 0 | 1.0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 2.2 |
| 8 | 0 | 0.7 | 0.5 | 0.7 | 1.0 | 0 | 0.7 | 1.0 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 4.6 |
| 9 | 0 | 0.7 | 0.7 | 0.7 | 0.7 | 0 | 0.7 | 0.7 | 1.0 | 0 | 0 | 0 | 0 | 0 | 0 | 5.2 |
| 10 | 0 | 0.5 | 0.5 | 0.7 | 0.5 | 0 | 0.7 | 0.5 | 0 | 1.0 | 0 | 0 | 0 | 0 | 0 | 4.4 |
| 11 | 0 | 0.7 | 0.7 | 0.7 | 0.9 | 0 | 0.7 | 0.9 | 0.7 | 0 | 1.0 | 0 | 0 | 0 | 0 | 6.3 |
| 12 | 0.3 | 0.7 | 0.7 | 0.7 | 0.3 | 0.7 | 0.7 | 0.3 | 0 | 0.3 | 0 | 1.0 | 0 | 0 | 0 | 5.7 |
| 13 | 0.3 | 0.7 | 0.7 | 0.7 | 0.7 | 0.7 | 0.7 | 0.3 | 0 | 0.3 | 0 | 0.7 | 1.0 | 0 | 0 | 6.8 |
| 14 | 0 | 0.1 | 0.5 | 0.5 | 0.5 | 0 | 0.5 | 0.1 | 0 | 0 | 0 | 0 | 0 | 1.0 | 0 | 3.2 |
| 15 | 0 | 0 | 0.5 | 0.5 | 0.9 | 0 | 0.5 | 0 | 0 | 0 | 0 | 0 | 0 | 0 | 1.0 | 3.4 |
| DEP | 1.9 | 6.1 | 8.3 | 8.1 | 6.8 | 2.4 | 8.1 | 4.1 | 1.7 | 1.9 | 1.0 | 1.7 | 1.0 | 1.0 | 1.0 | |
| Notes: B(i/j) – Barrier in line i, or column j; DVP – driving power; DEP – dependence power. | ||||||||||||||||
| Code | Mitigation measure description | Main barriers |
Autonomous cluster | Dependent cluster |
|---|---|---|---|---|
| MM1 | Government funding of research studies to evaluate and collect feedback on BIMI | B:6,8, 9,10,12,13 | B1 | B:3,4,5,7 |
| MM2 | Promoting collaboration with industry leaders to build the necessary support and knowledge base on BIMI | B:6,8,10,12,13 | B:1,14,15 | B:2,3,4,5,7 |
| MM3 | Implementation of Integrated Project Delivery (IPD) | B:6,8,10,12,13 | B1 | B:2,3,4,5,7 |
| MM4 | Creation of BIMI pilot projects through consortium participation of multiple organizations | B:6,8,10,12,13 | B:1,14 | B:2,3,4,5,7 |
| MM5 | Promoting joint work between industry and experts to assess current processes and structures to have a phased implementation of BIM | B:6,8,9,10,12,13 | B:1,15 | B:3,4,5,7 |
| MM6 | Introduction of BIM in university curricula and promoting research on this topic | B:6,8,9,10,11,12 | B1 | B:2,3,4,5,7 |
| MM7 | Organization of BIM training seminars and workshops to raise awareness and encourage professional development | B:6,8,9,10,11,12 | B1 | B:2,3,4,5,7 |
| MM8 | Organization of BIM awareness seminars and conferences aimed at top management | B:6,8,10,12 | B:1,14,15 | B:2,3,4,5,7 |
| MM9 | Development of government-led legislation and guides to BIMI, as well as subsidizing BIM-related costs | B:6,8,10,12 | B:1,14,15 | B:2,3,4,5,7 |
| MM10 | Development awareness campaigns aimed at all entities of the construction industry | B:6,8,9,10,11,12 | B1 | B:2,3,4,5,7 |
| MM11 | Creation of incentives, in the form of prizes, for organizations that effectively implement BIM | B:6,8,9,10 | B:1,14 | B:2,3,4,5,7 |
| MM12 | Prioritization of BIM-capable professionals when hiring | B:8,9,10,11 | B:3,4,5,7 | |
| MM13 | Involvement of employees in the BIM implementation process from the beginning | B:8,9,10,11 | B:4,5,7 | |
| MM14 | Sharing BIM-related expenses among entities involved in construction projects | B8 | B:2,3,4 |
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content. |
© 2024 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (http://creativecommons.org/licenses/by/4.0/).
